Running an HVAC business with Odoo

How do I manage an HVAC installation project in Odoo?

Workflow overview: How do I manage an HVAC installation project in Odoo?
Workflow overview. Instructional screenshots show the actual demo interface.

Create a sales-linked HVAC installation project in Odoo, assign the work and verify native task dependencies with the owner and technician.

Alex needs preparation, installation work and office handoff to stay connected to the installation-service sale. We configure Odoo’s native Project & Task option, confirm one fictional service order and build a three-task sequence. The test shows what Waiting means, when a completed predecessor releases work and how private-task access changes what the technician can see.

Alex Rivera and Demo Air HVAC are fictional training examples. Prices, dates, quantities and business situations in this guide are illustrative.

Before you begin

Tested in stock Odoo 20.0-20260926 Community as the demo owner administrator, with official modules and standard configuration. Complete H25 equipment quotation and options and H41 sales-generated tasks. Use the existing Demo Property H08 customer and the technician account prepared in H42. Official Project, Sales–Project, Timesheets and Sales–Timesheets integrations are installed. Preserve H25’s S00006 draft, its equipment and the existing service project/task. This separate sale covers one fictional $600 installation-service Unit. Equipment procurement and commissioning are outside it. The owner’s confirmation and preparation completion are deliberate local test actions; they do not establish actual customer approval, technical readiness or completed installation. Keep messages in the local mail sink.

Step-by-step workflow

Step 1. Configure a separate installation service

Open Sales → Products → Products → New. Name it Demo Installation Service H47, keep Sales checked, clear Purchase and select Service. Set $600 per Units and Reference H47-INSTALL. Selecting Service initially changed the unit to Hours in this runtime, so explicitly select Units. Choose Create on Order → Project & Task, leave Project Template empty and keep Invoicing Policy → Prepaid/Fixed Price. Save and reopen. This policy makes the ordered service invoiceable independently of task completion; it is not a milestone billing setup.

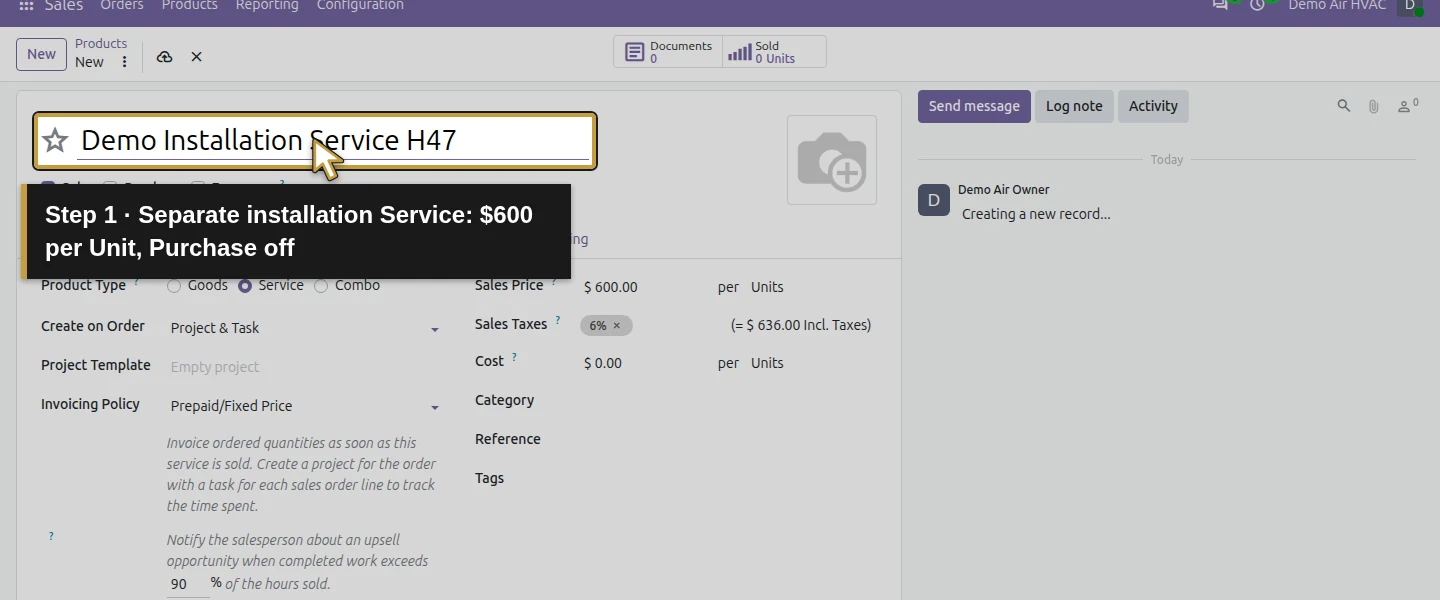

Action 1: Separate installation Service: $600 per Unit, Purchase off. The actual target is highlighted in gold.
Separate installation Service: $600 per Unit, Purchase off.

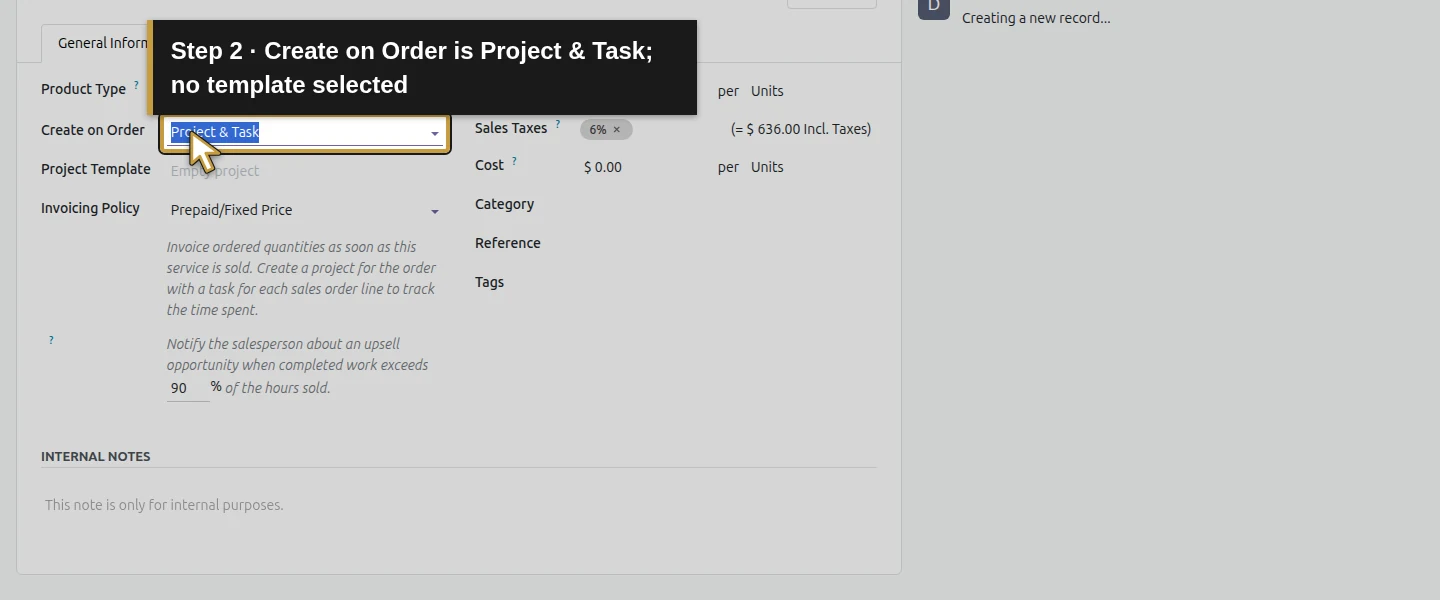

Action 2: Create on Order is Project & Task; no template selected. The actual target is highlighted in gold.
Create on Order is Project & Task; no template selected.

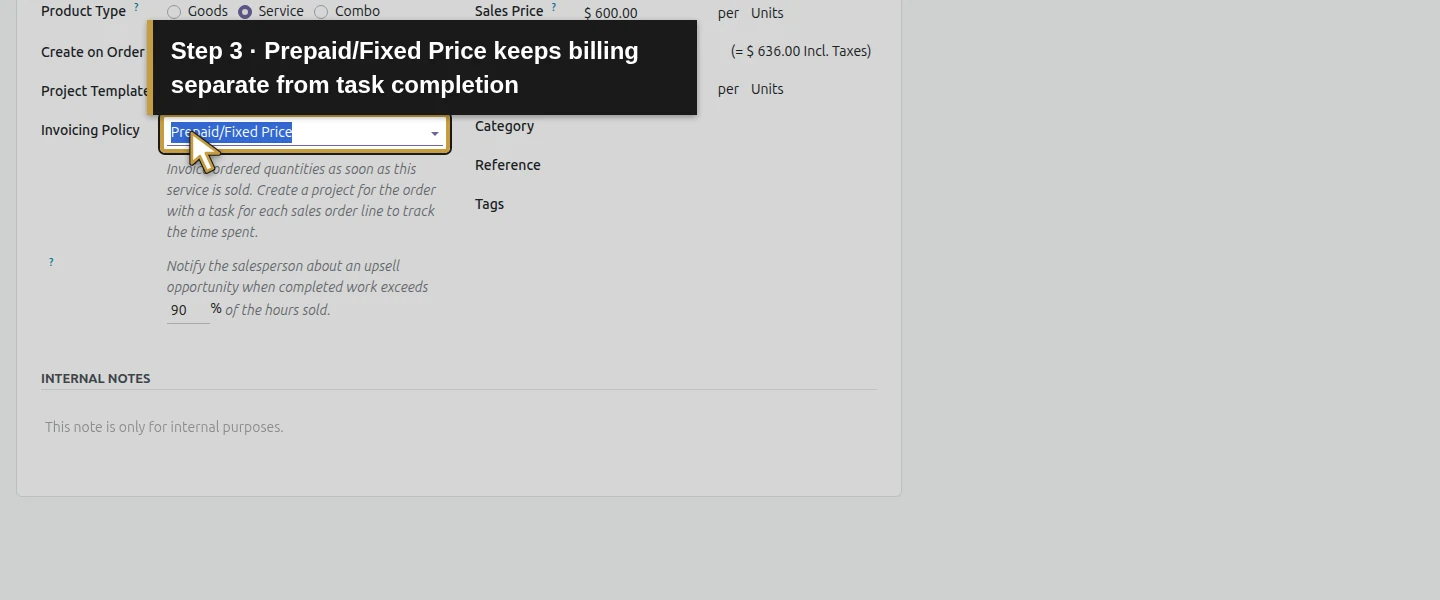

Action 3: Prepaid/Fixed Price keeps billing separate from task completion. The actual target is highlighted in gold.
Prepaid/Fixed Price keeps billing separate from task completion.

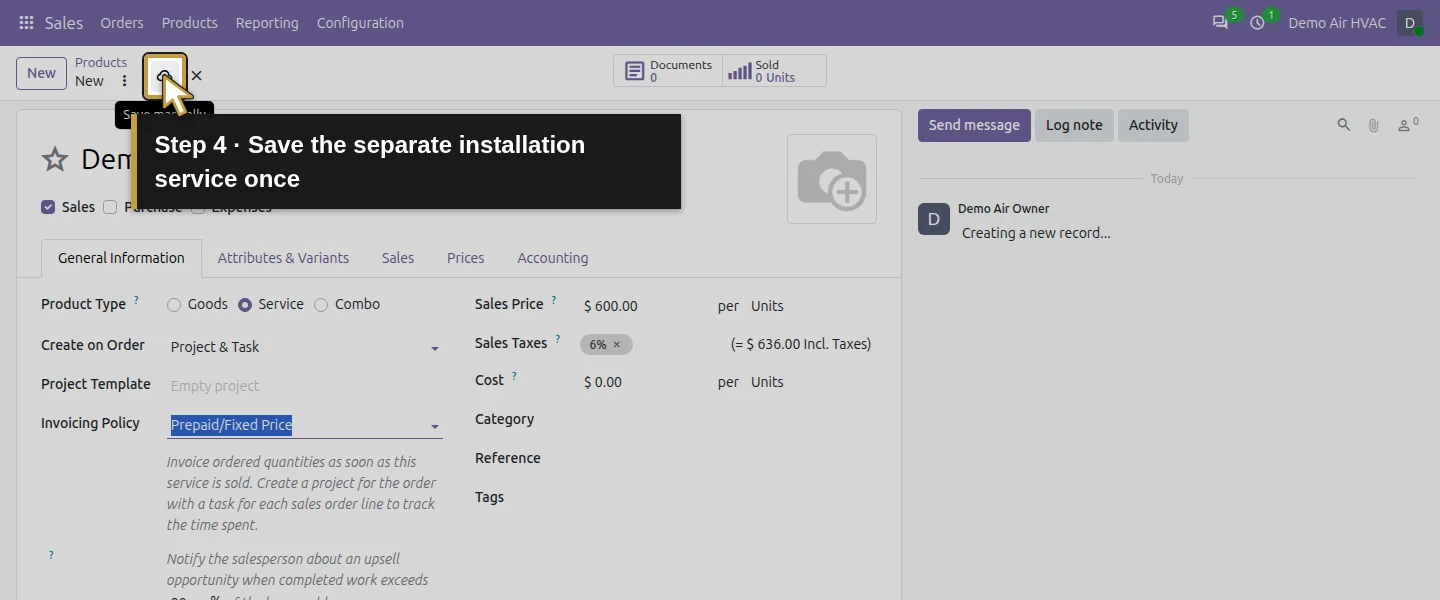

Action 4: Save the separate installation service once. The actual target is highlighted in gold.
Save the separate installation service once.

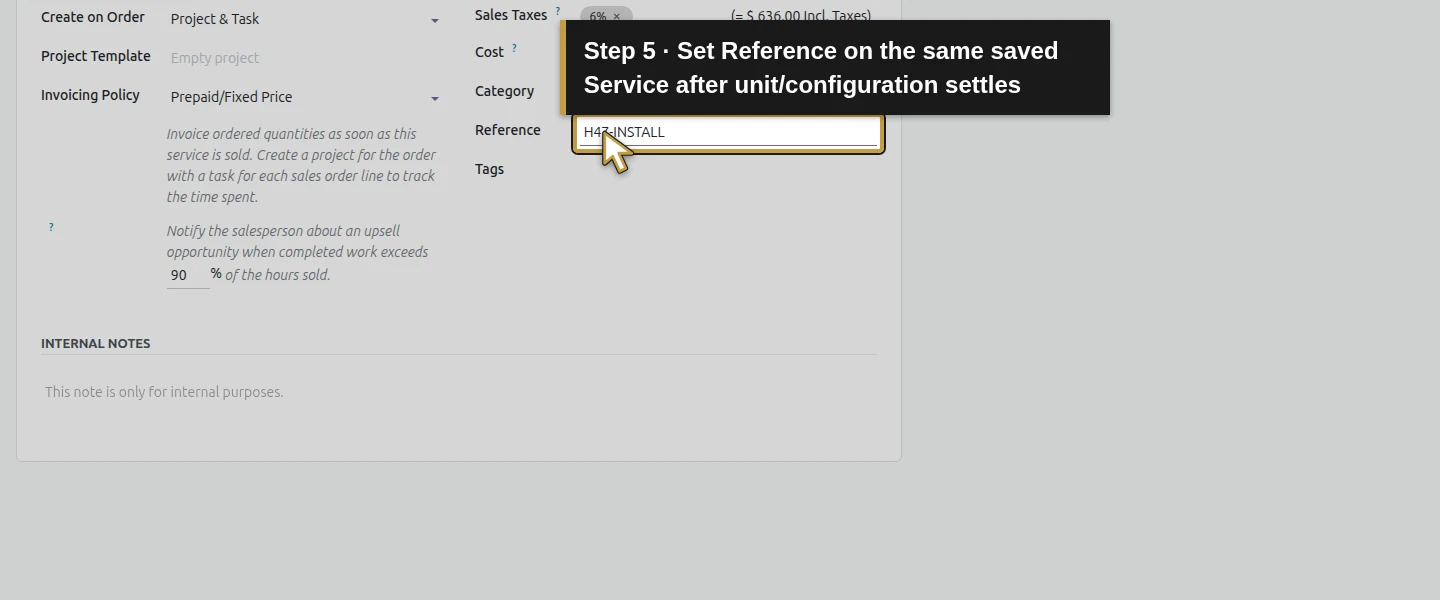

Action 5: Set Reference on the same saved Service after unit/configuration settles. The actual target is highlighted in gold.
Set Reference on the same saved Service after unit/configuration settles.

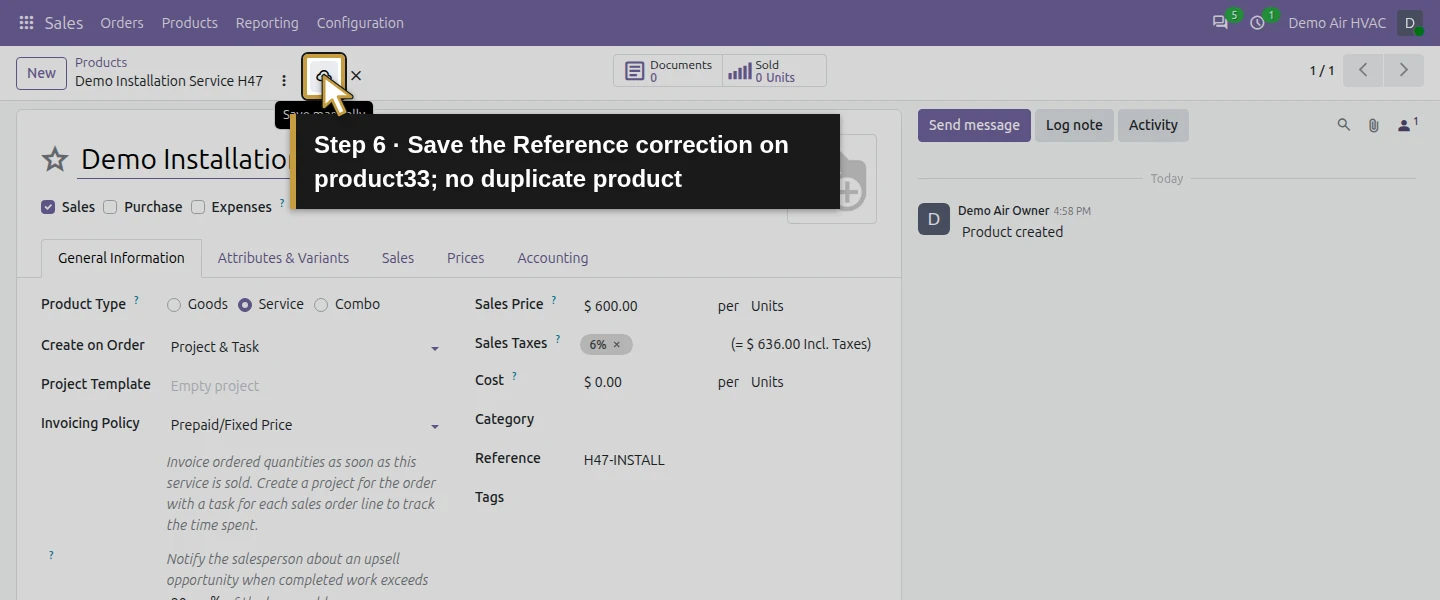

Action 6: Save the Reference correction on product33; no duplicate product. The actual target is highlighted in gold.
Save the Reference correction on product33; no duplicate product.

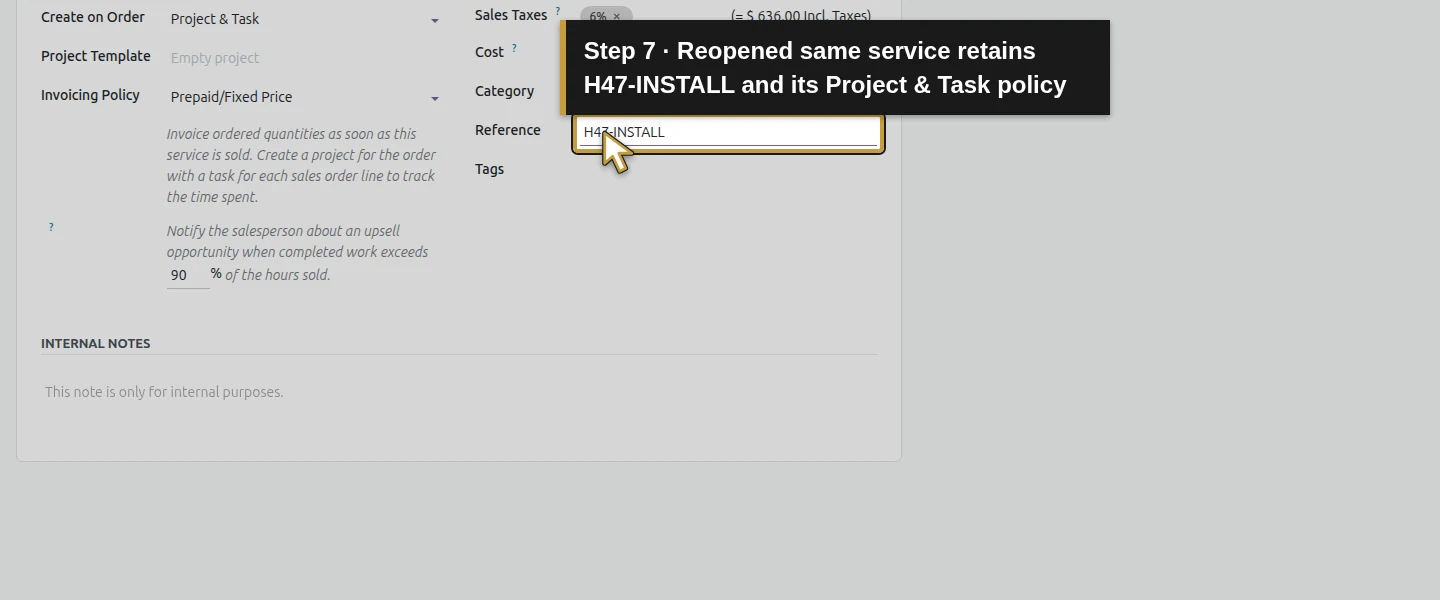

Action 7: Reopened same service retains H47-INSTALL and its Project & Task policy. The actual target is highlighted in gold.
Reopened same service retains H47-INSTALL and its Project & Task policy.

Step 2. Prepare one separate installation-service quotation

In Sales, use New → New Quotation, select Demo Property H08, then Add Line and select the actual H47 installation service. Keep 1 Unit at $600. The existing billing/service addresses are Billing Office H08 and Service Site H08. In Other Info, set Customer Reference to DEMO-H47-INSTALL-001 — Fictional replacement installation planning; no visit confirmed. Clear Online signature for this owner-confirmed training trigger and save. S00011 totals $600 + $36 illustrative tax = $636. H25’s equipment quotation remains separate; do not imply its equipment was sold or supplied by this service-only order.

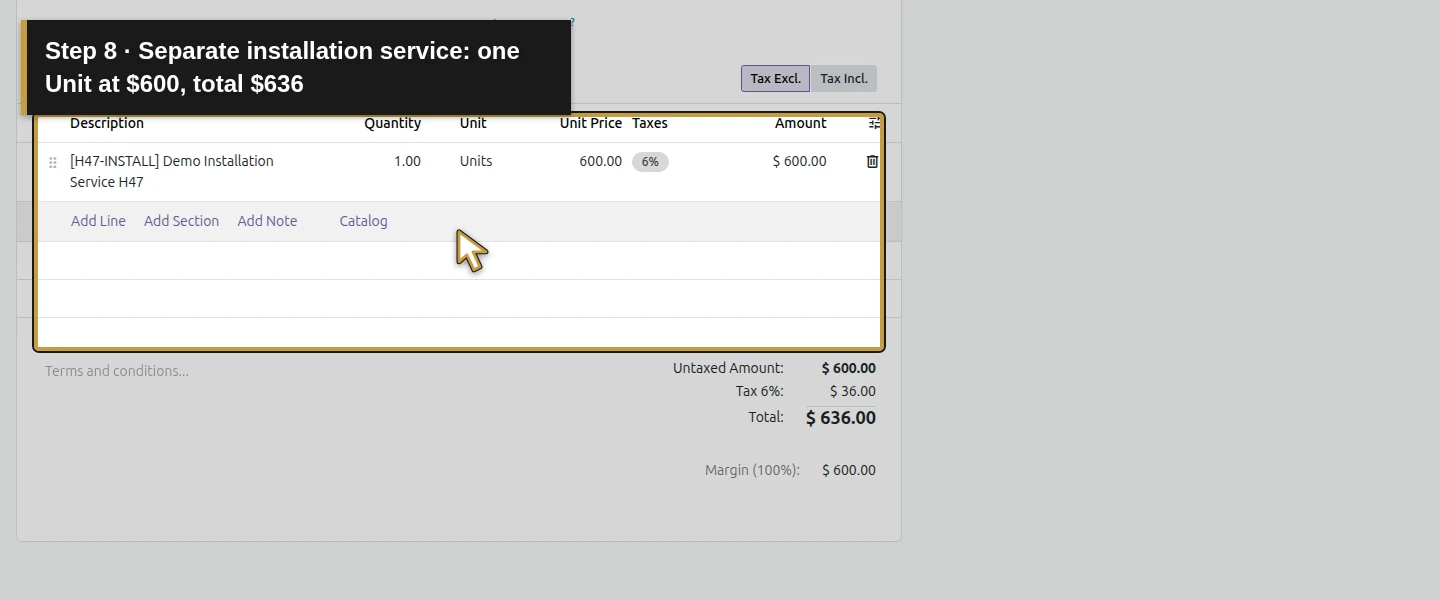

Action 8: Separate installation service: one Unit at $600, total $636. The actual target is highlighted in gold.
Separate installation service: one Unit at $600, total $636.

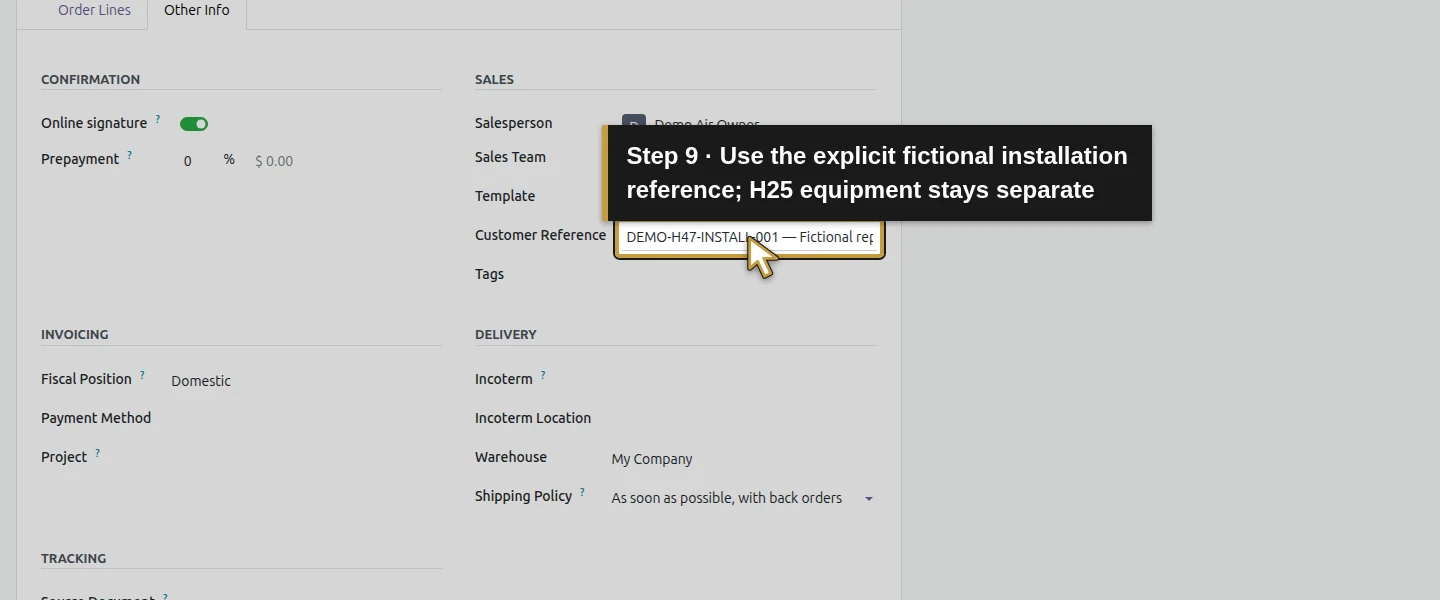

Action 9: Use the explicit fictional installation reference; H25 equipment stays separate. The actual target is highlighted in gold.
Use the explicit fictional installation reference; H25 equipment stays separate.

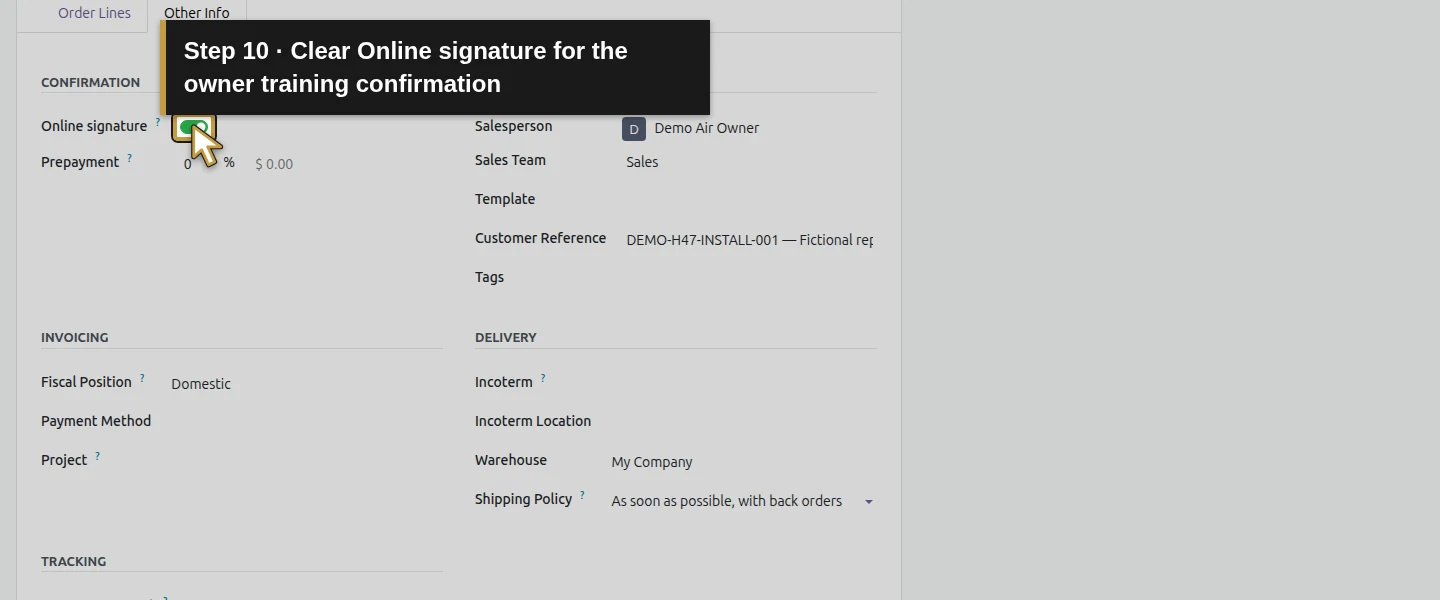

Action 10: Clear Online signature for the owner training confirmation. The actual target is highlighted in gold.
Clear Online signature for the owner training confirmation.

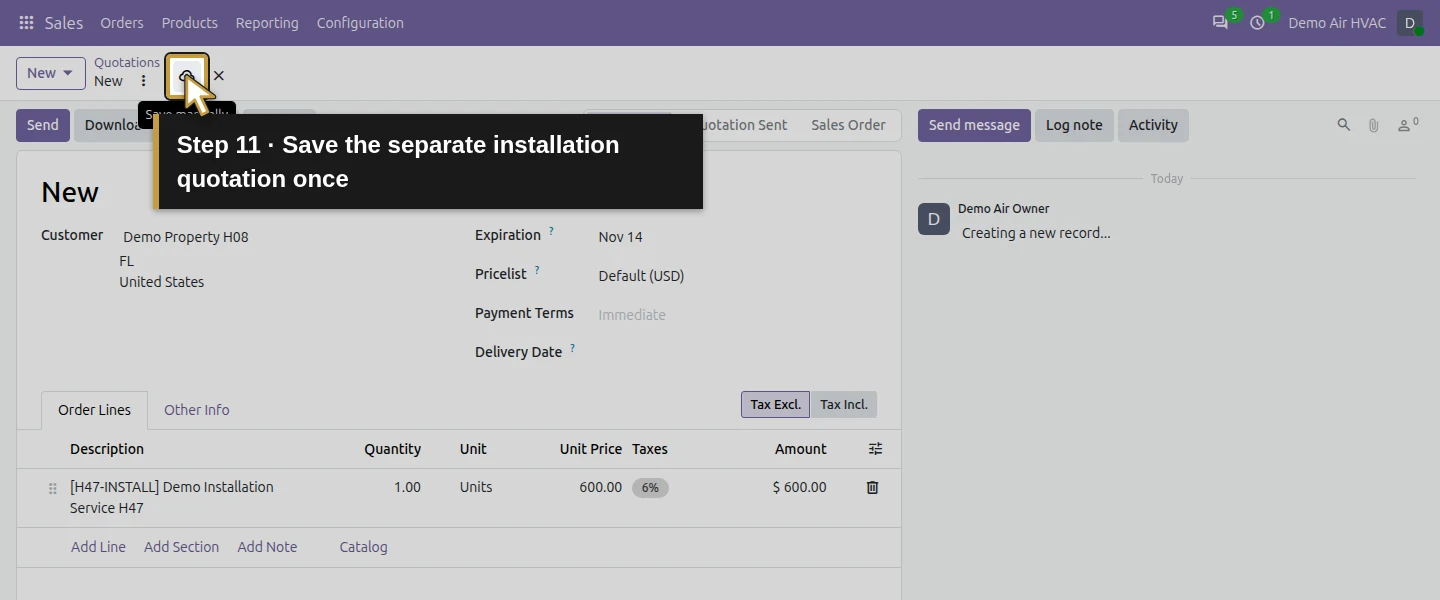

Action 11: Save the separate installation quotation once. The actual target is highlighted in gold.
Save the separate installation quotation once.

Step 3. Confirm once and inspect the generated project and task

Click Confirm once. The sale gains 1 Projects / 1 Tasks. Click that button to open the new project’s board and its generated [H47-INSTALL] Demo Installation Service H47 task. Confirmation created a new project, rather than adding the job to H40’s service project. The task has the parent customer and S00011 sales-line link, but its Description, Assignees and Deadline are empty. It initially has 1h Allocated Time, even though this sale is one service Unit; that value is not a reviewed installation estimate.

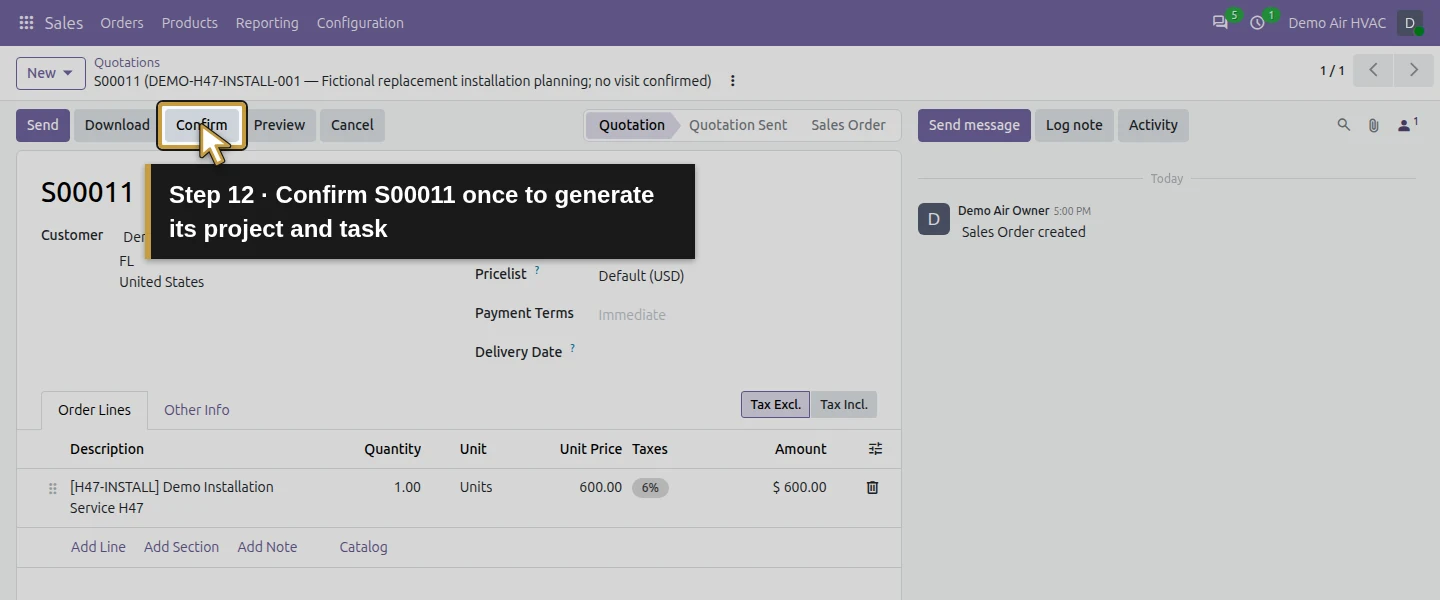

Action 12: Confirm S00011 once to generate its project and task. The actual target is highlighted in gold.
Confirm S00011 once to generate its project and task.

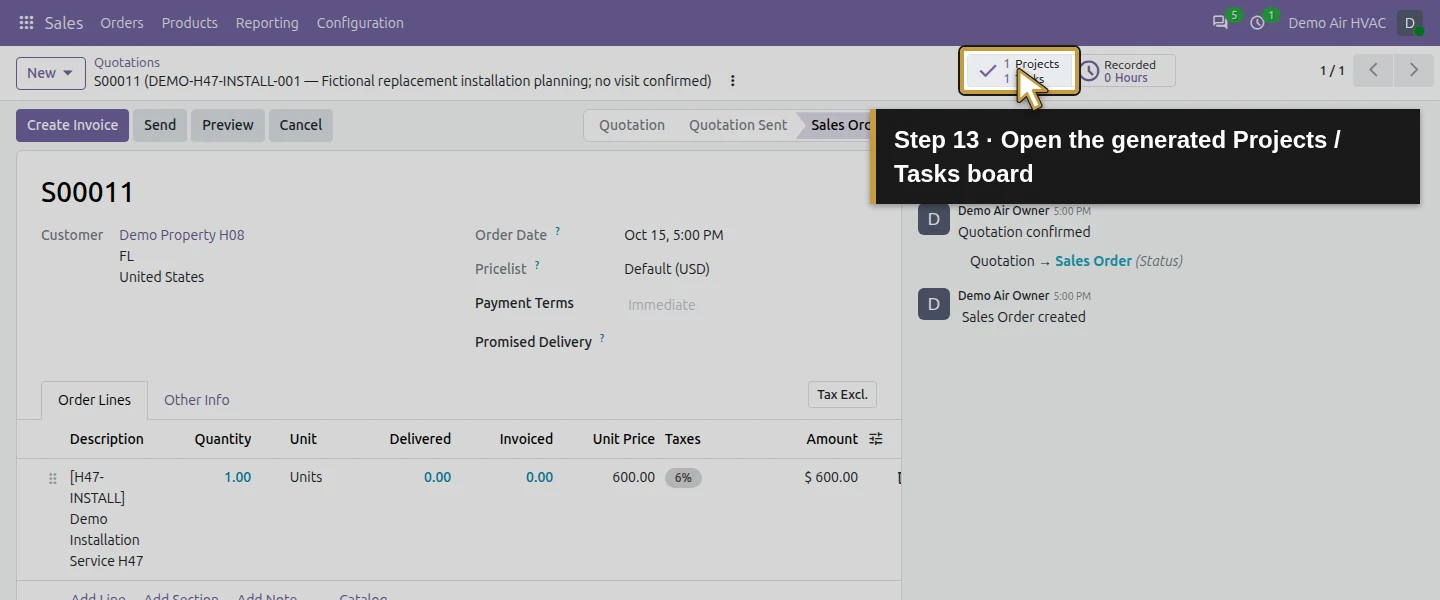

Action 13: Open the generated Projects / Tasks board. The actual target is highlighted in gold.
Open the generated Projects / Tasks board.

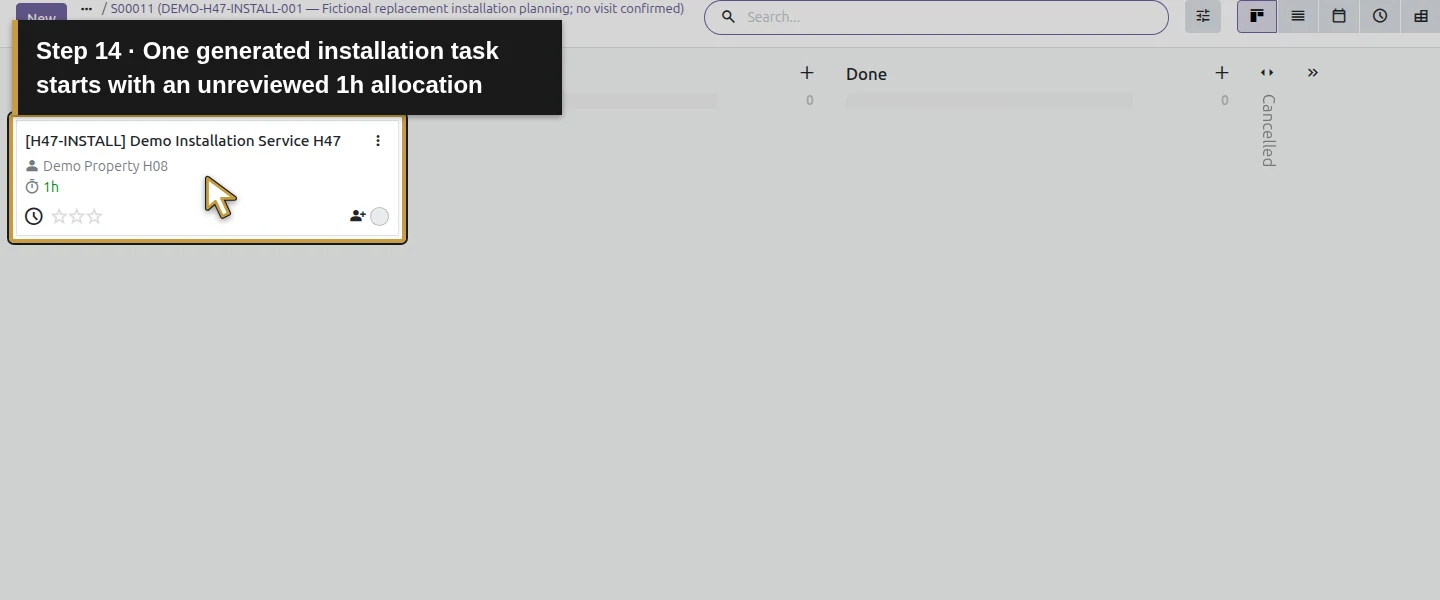

Action 14: One generated installation task starts with an unreviewed 1h allocation. The actual target is highlighted in gold.
One generated installation task starts with an unreviewed 1h allocation.

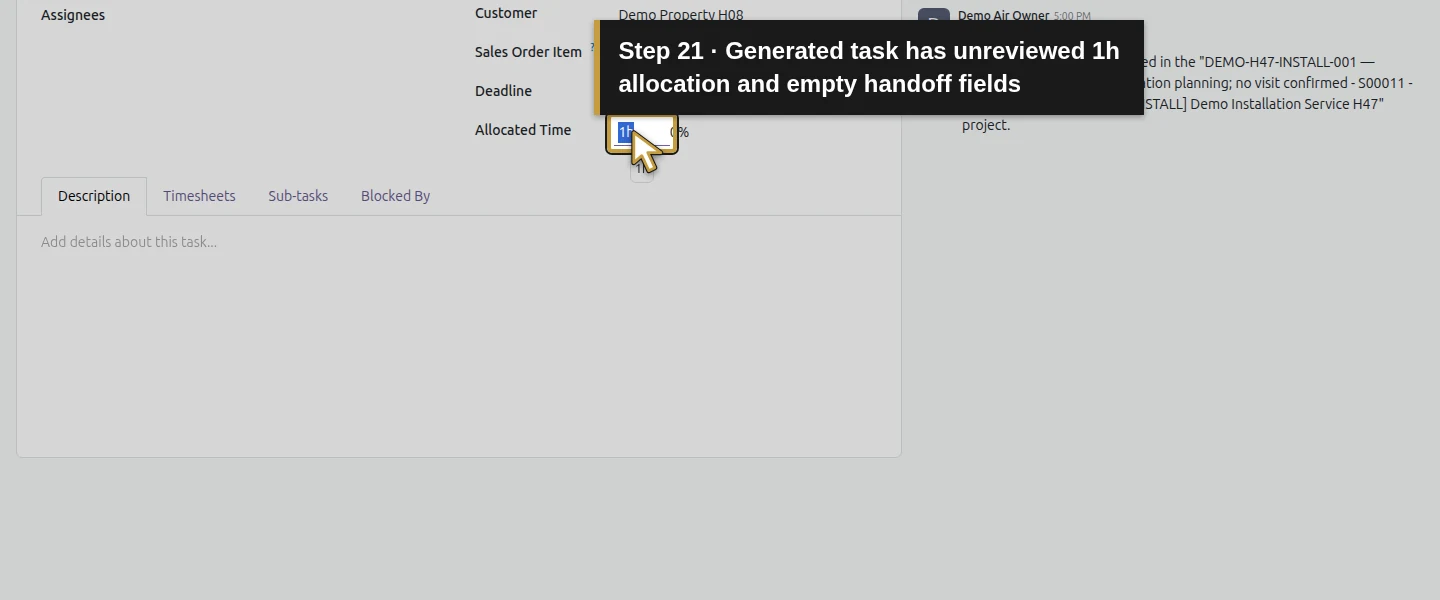

Action 21: Generated task has unreviewed 1h allocation and empty handoff fields. The actual target is highlighted in gold.
Generated task has unreviewed 1h allocation and empty handoff fields.

Step 4. Set the generated project’s name, manager and visibility

Open Project → Projects. Find the new card by its S00011/H47 reference, open its more_vert → Settings and rename it Demo Installation H47 — S00011. Select the existing Demo Air Owner as Project Manager; choose the existing user, not the Invite option. On the Settings tab, change Visibility from All internal users and invited portal users to Team members only. Enable Task Dependencies, keep the existing Timesheets/Billable settings and click Save manually. No portal invitation or new project template is created.

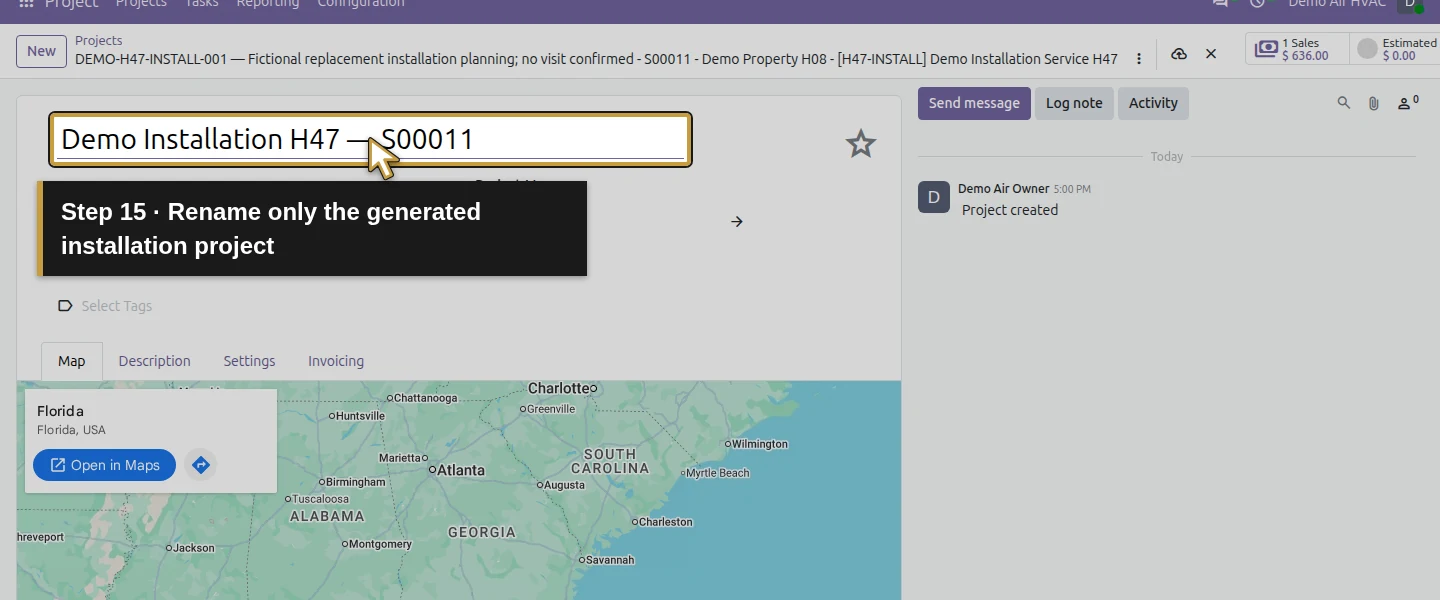

Action 15: Rename only the generated installation project. The actual target is highlighted in gold.
Rename only the generated installation project.

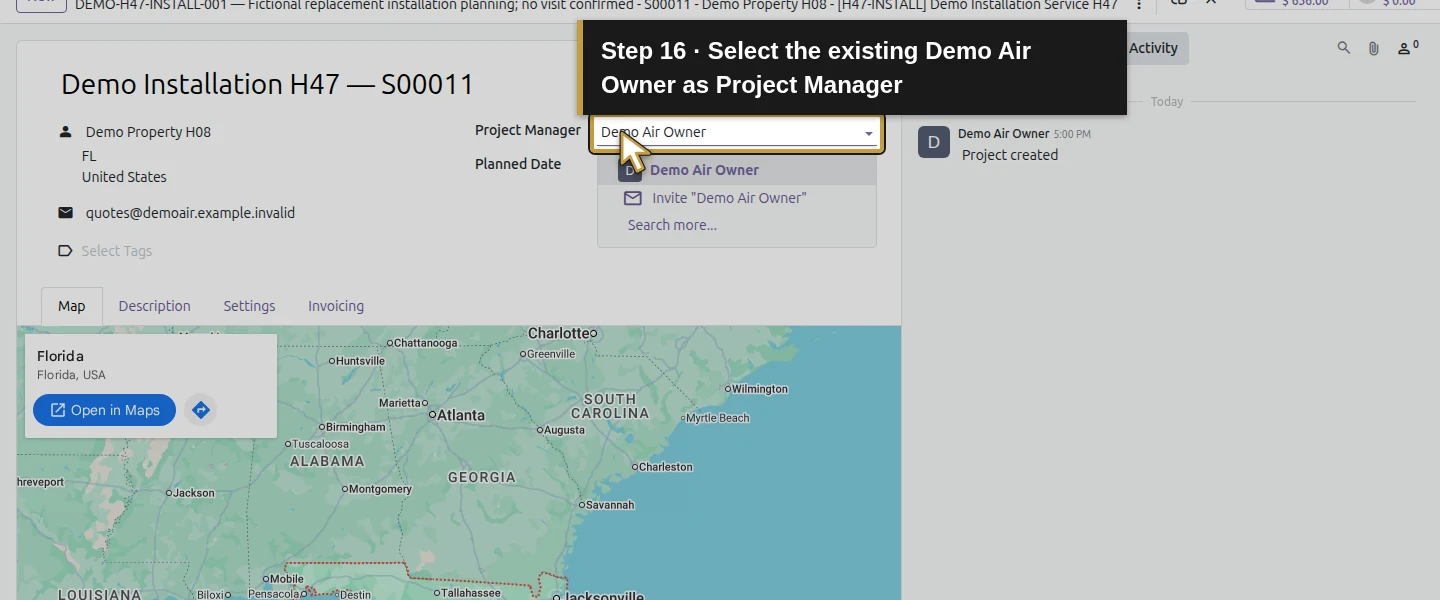

Action 16: Select the existing Demo Air Owner as Project Manager. The actual target is highlighted in gold.
Select the existing Demo Air Owner as Project Manager.

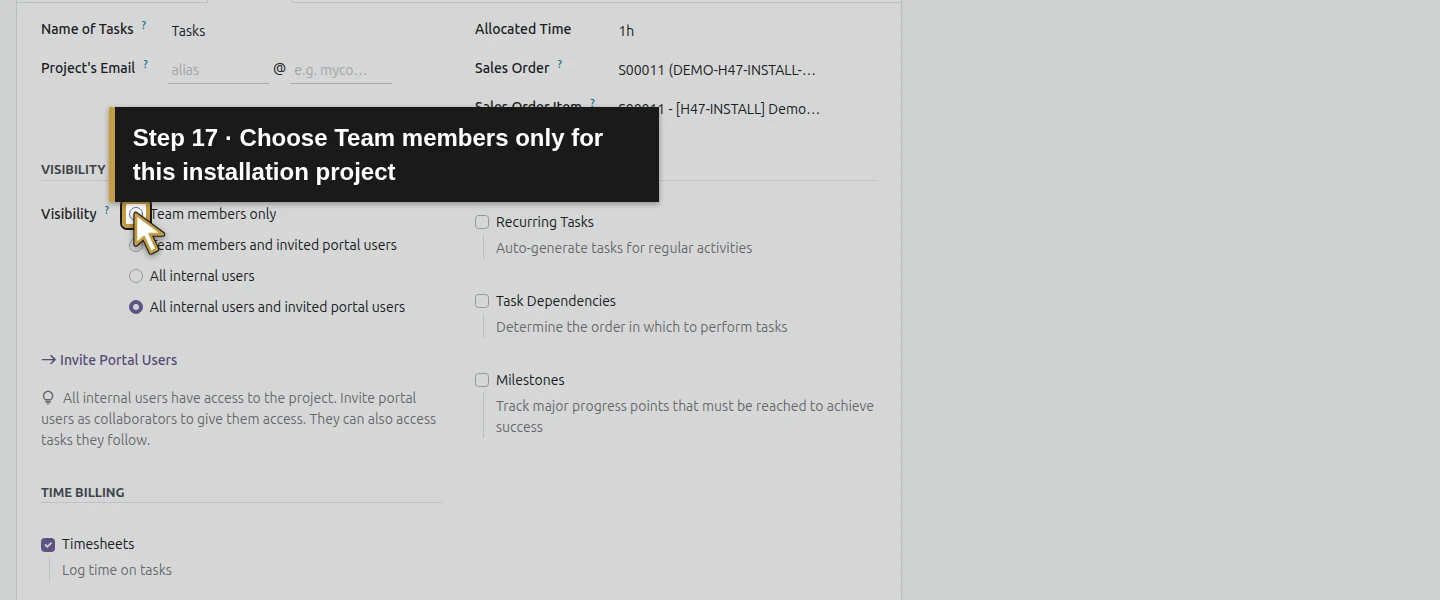

Action 17: Choose Team members only for this installation project. The actual target is highlighted in gold.
Choose Team members only for this installation project.

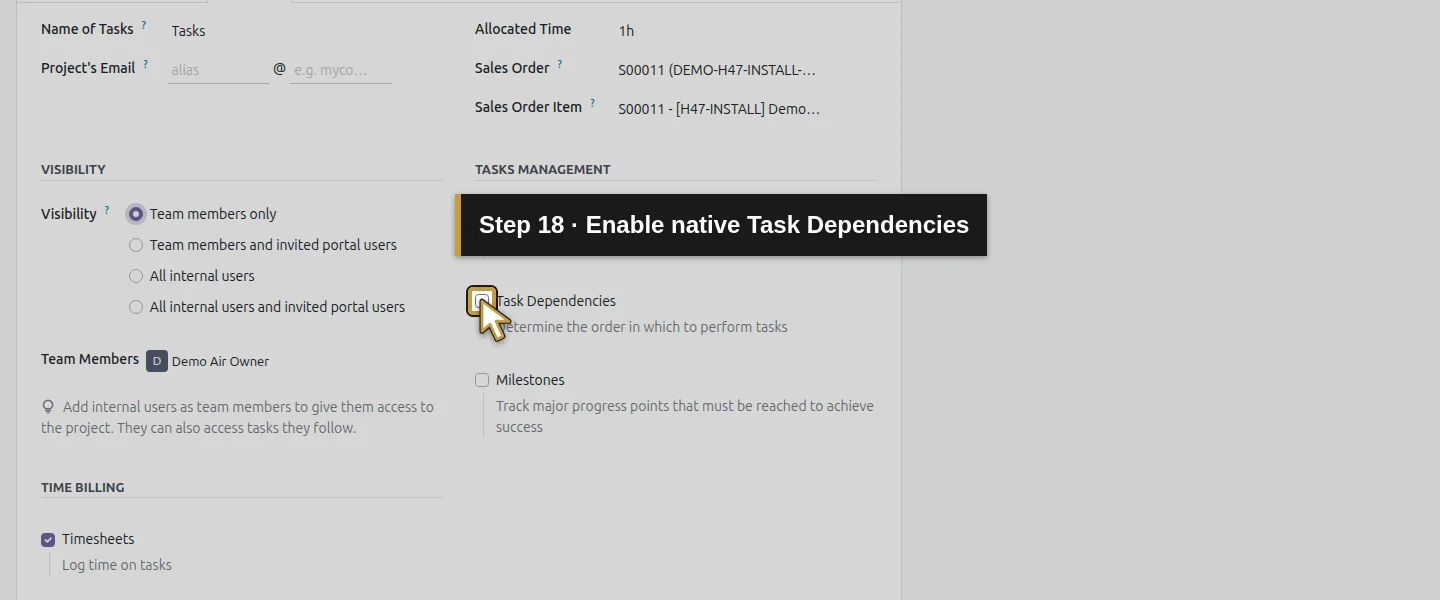

Action 18: Enable native Task Dependencies. The actual target is highlighted in gold.
Enable native Task Dependencies.

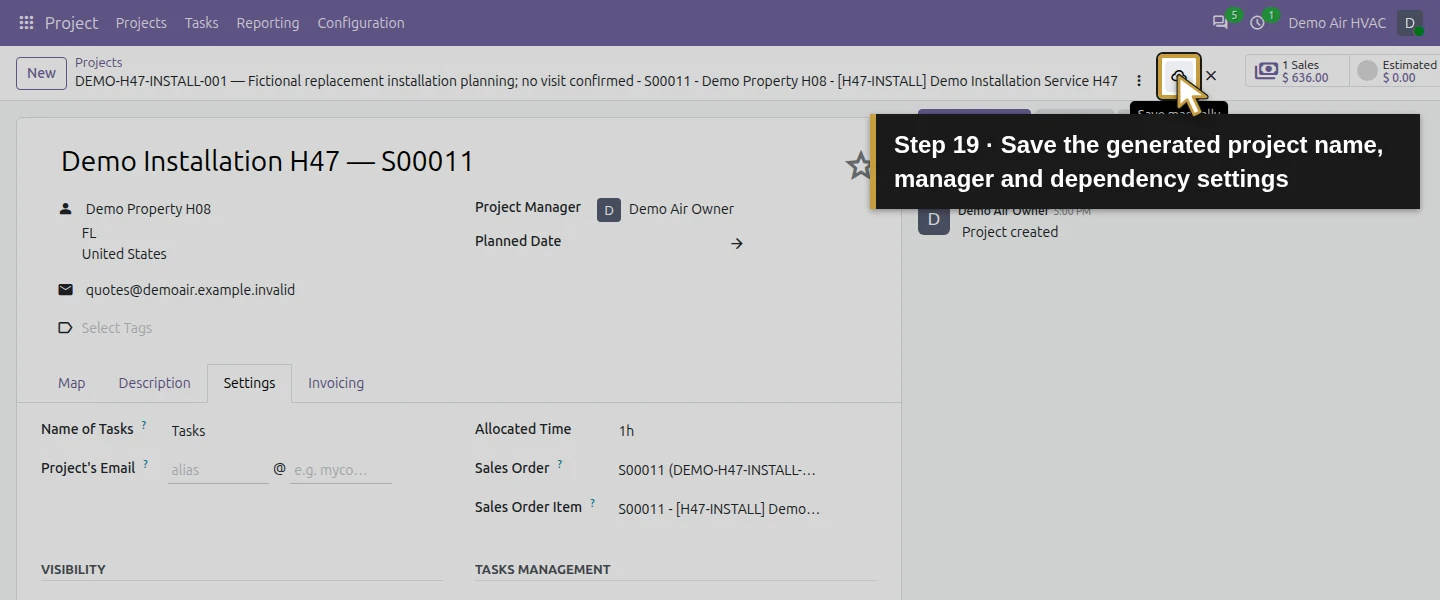

Action 19: Save the generated project name, manager and dependency settings. The actual target is highlighted in gold.
Save the generated project name, manager and dependency settings.

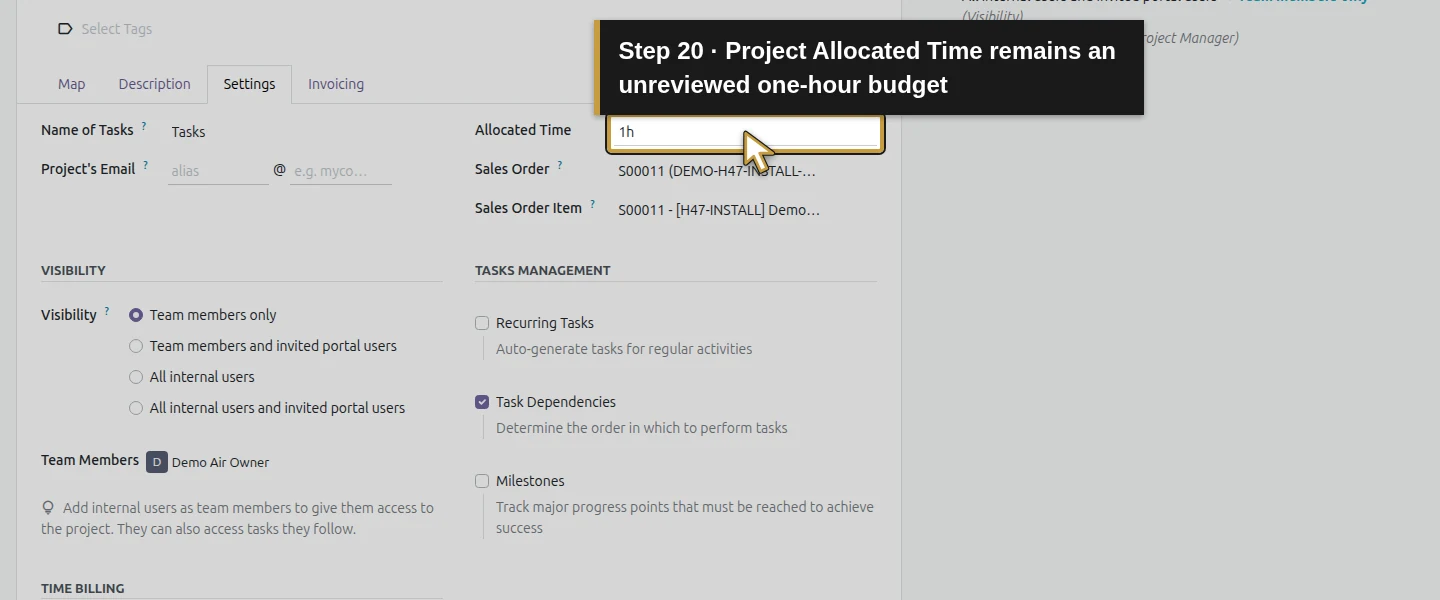

Action 20: Project Allocated Time remains an unreviewed one-hour budget. The actual target is highlighted in gold.
Project Allocated Time remains an unreviewed one-hour budget.

Step 5. Add the installation handoff details

Open the project’s Tasks and the existing generated task. In Description, identify S00011, the service-only scope and manual site reference Service Site H08, 205 Demo Service Lane, North Fort Myers. Note the proposed H13-3T equipment context from H25, that S00006 remains a separate draft, and the checks still needed for scope, equipment, access, permissions and technician availability. State that no appointment or actual work is established. Select Demo Technician H42 in Assignees, set Deadline October 23, 2026 at 4 PM America/New_York, and change the unreviewed task Allocated Time from 1h to 0. Save and wait. This internal deadline does not book a calendar visit.

Action 21: Generated task has unreviewed 1h allocation and empty handoff fields. The actual target is highlighted in gold.
Generated task has unreviewed 1h allocation and empty handoff fields.

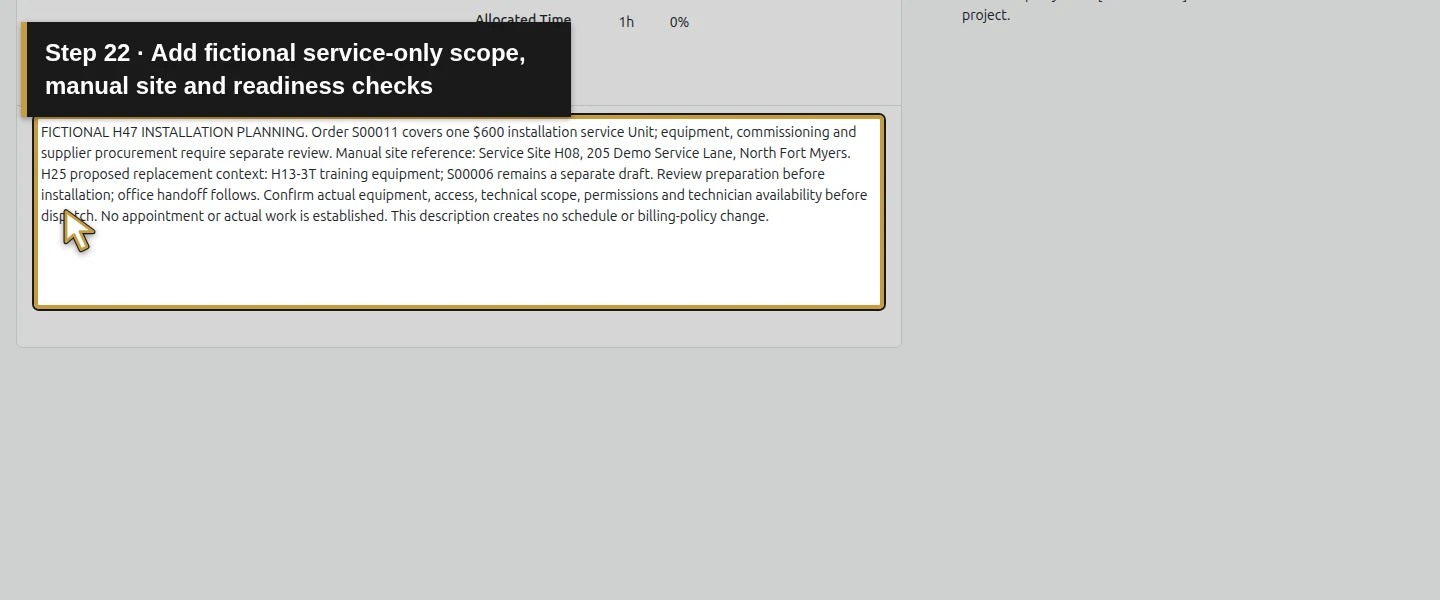

Action 22: Add fictional service-only scope, manual site and readiness checks. The actual target is highlighted in gold.
Add fictional service-only scope, manual site and readiness checks.

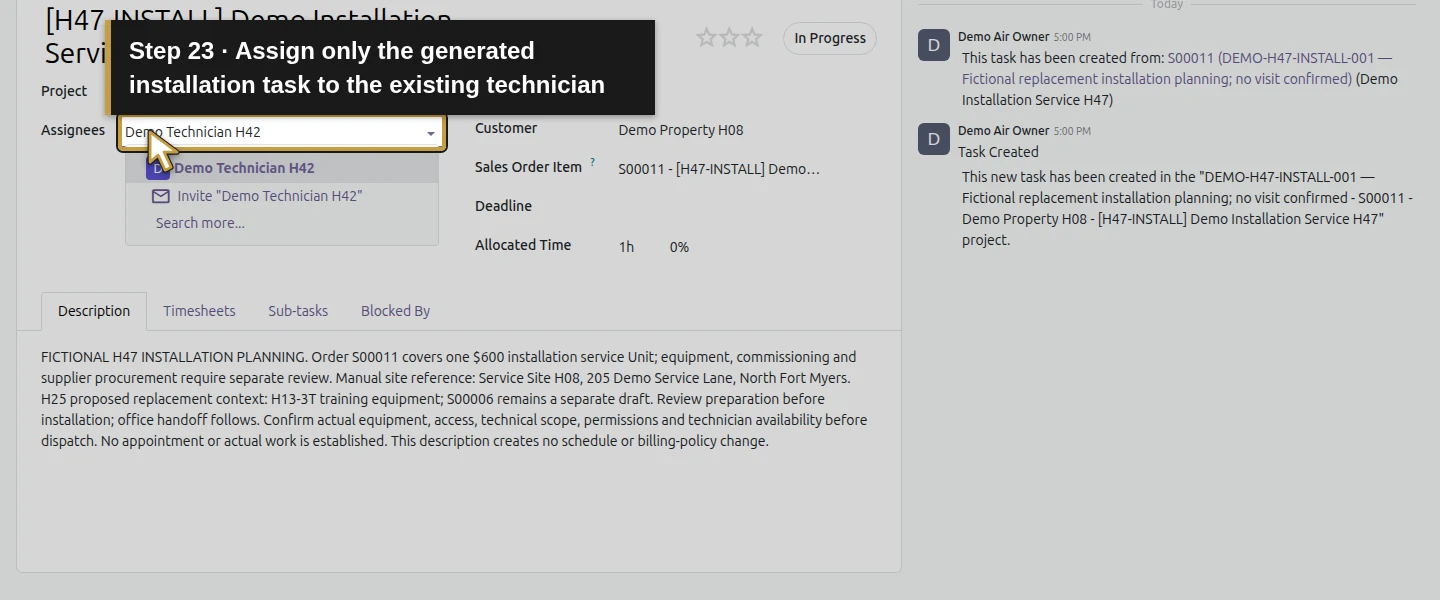

Action 23: Assign only the generated installation task to the existing technician. The actual target is highlighted in gold.
Assign only the generated installation task to the existing technician.

Action 24: Set internal deadline October23,2026 at4PM New York; no appointment. The actual target is highlighted in gold.
Set internal deadline October23,2026 at4PM New York; no appointment.

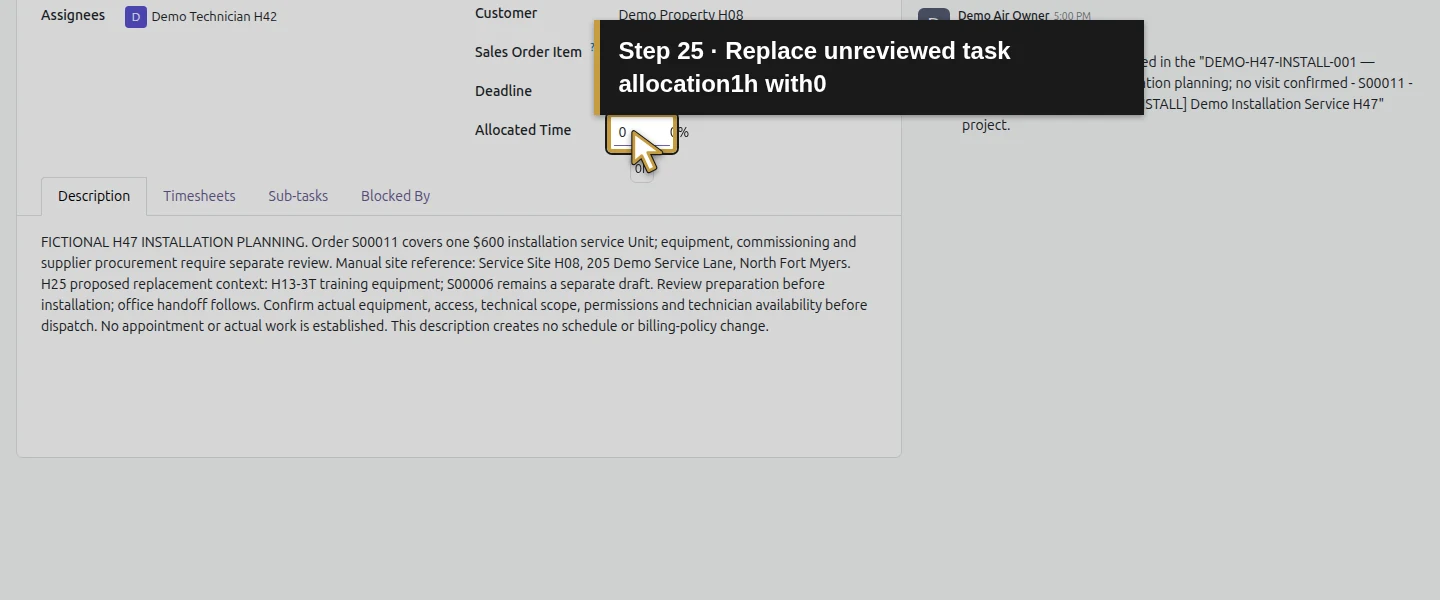

Action 25: Replace unreviewed task allocation1h with0. The actual target is highlighted in gold.
Replace unreviewed task allocation1h with0.

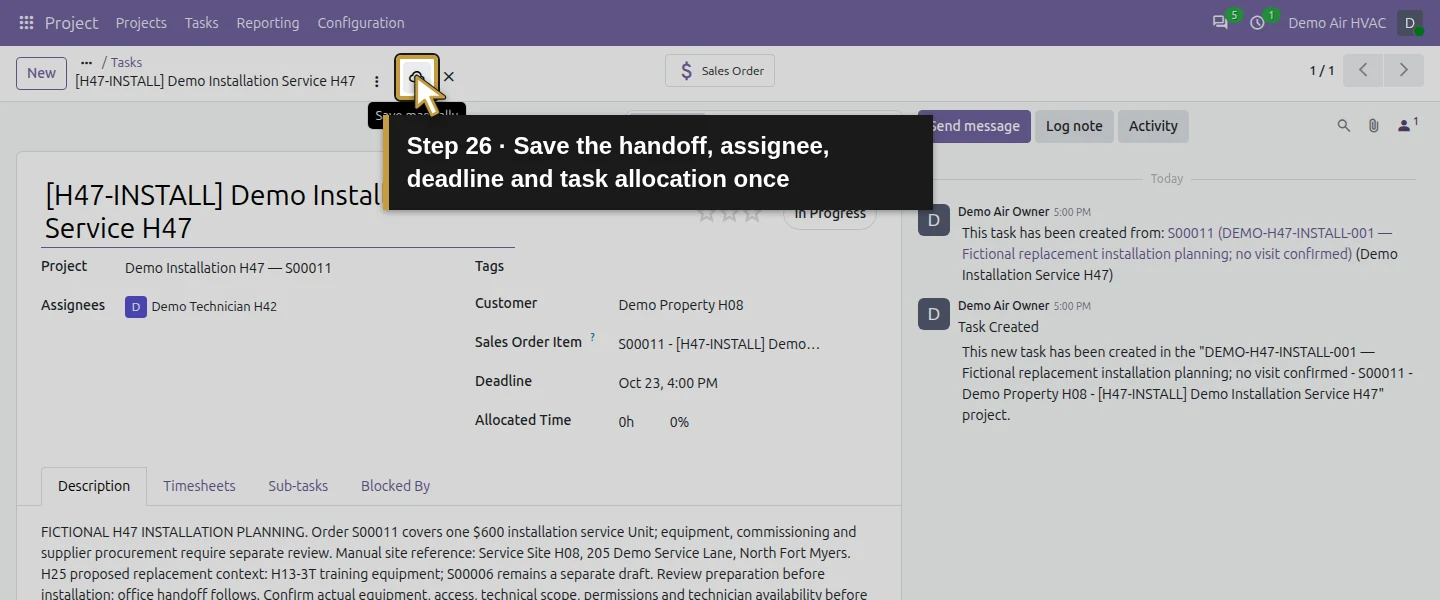

Action 26: Save the handoff, assignee, deadline and task allocation once. The actual target is highlighted in gold.
Save the handoff, assignee, deadline and task allocation once.

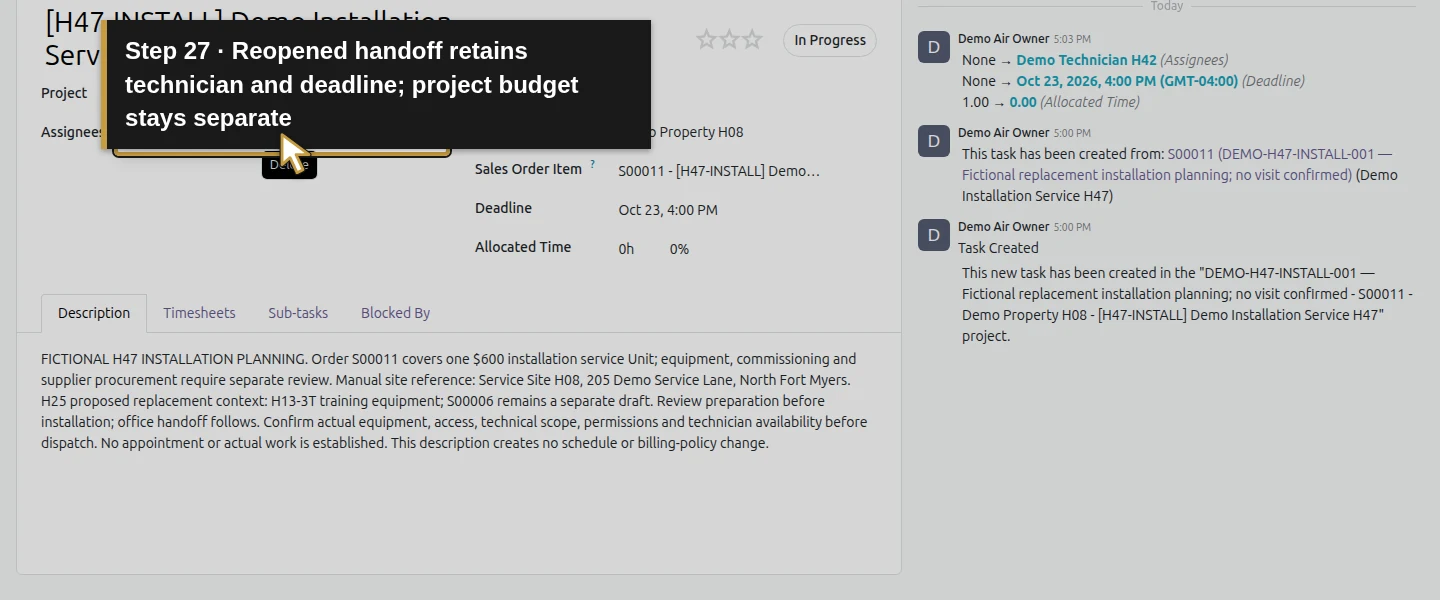

Action 27: Reopened handoff retains technician and deadline; project budget stays separate. The actual target is highlighted in gold.
Reopened handoff retains technician and deadline; project budget stays separate.

Step 6. Create the preparation and office-handoff tasks

Return to this project’s board. Click New, enter H47 Preparation review, choose Demo Air Owner and click Add. Open it, describe the fictional scope/access/equipment/availability review and save. Repeat for H47 Office handoff review, assigned to the owner, with instructions to review actual work notes, photos, materials, time and scope changes before deciding closure or billing. The tasks inherit the project’s customer and S00011 Sales Order Item in this case; verify those values. These are two manual tasks beside the generated installation task, not two additional sold service units.

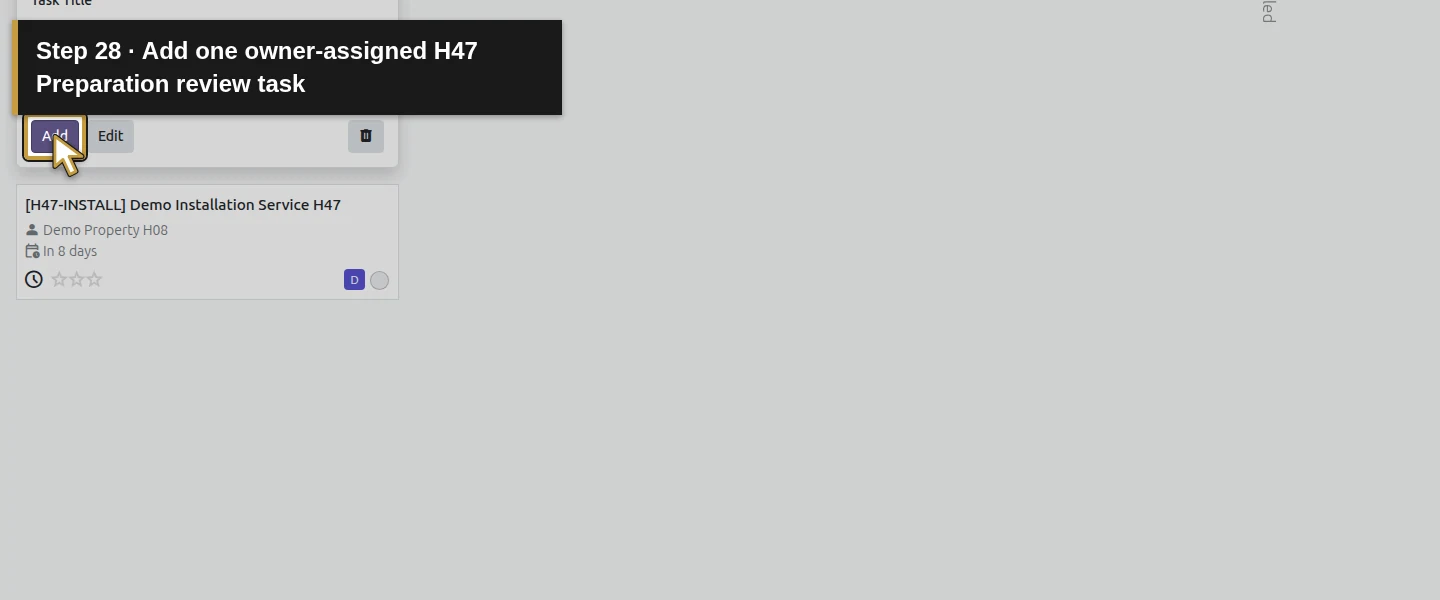

Action 28: Add one owner-assigned H47 Preparation review task. The actual target is highlighted in gold.
Add one owner-assigned H47 Preparation review task.
Action 29: Describe the fictional preparation review and its remaining checks. The actual target is highlighted in gold.
Describe the fictional preparation review and its remaining checks.

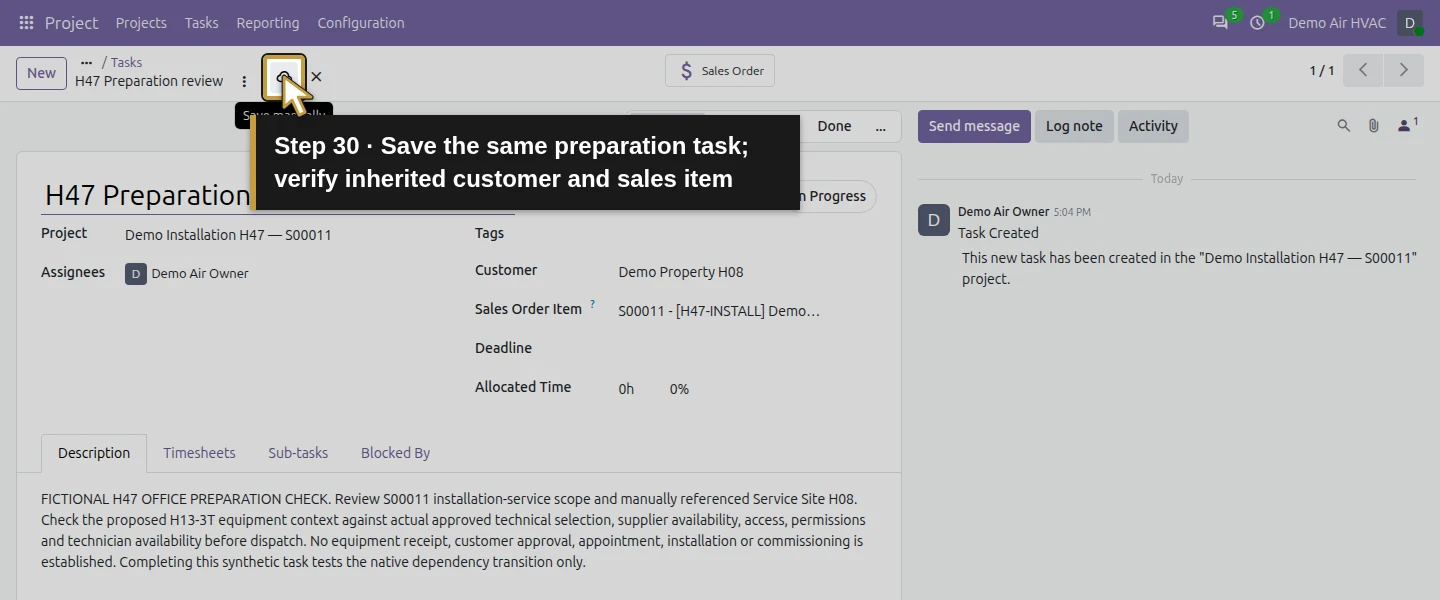

Action 30: Save the same preparation task; verify inherited customer and sales item. The actual target is highlighted in gold.
Save the same preparation task; verify inherited customer and sales item.

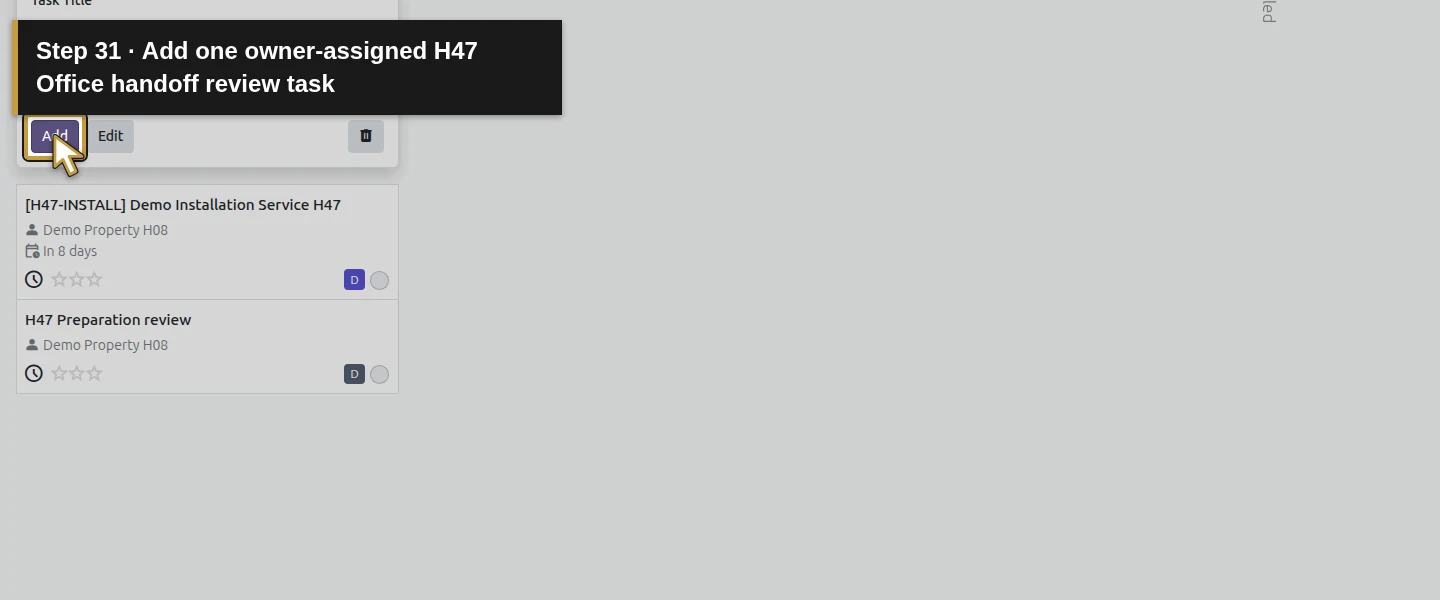

Action 31: Add one owner-assigned H47 Office handoff review task. The actual target is highlighted in gold.
Add one owner-assigned H47 Office handoff review task.

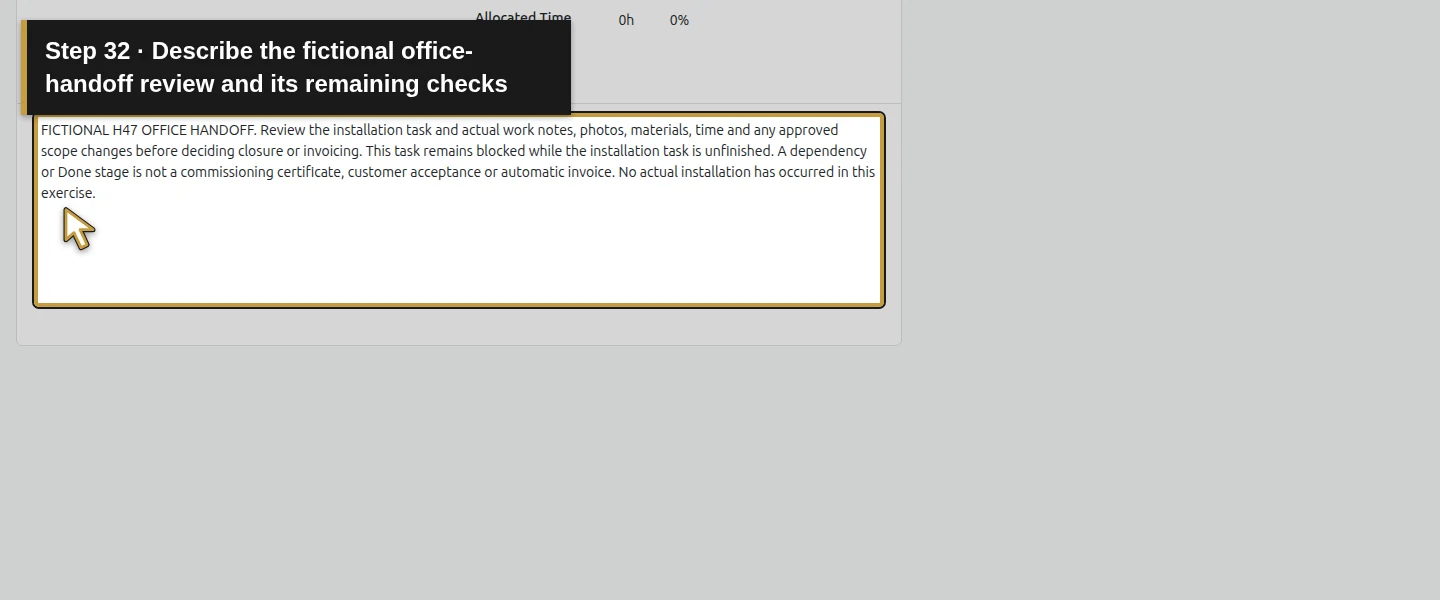

Action 32: Describe the fictional office-handoff review and its remaining checks. The actual target is highlighted in gold.
Describe the fictional office-handoff review and its remaining checks.

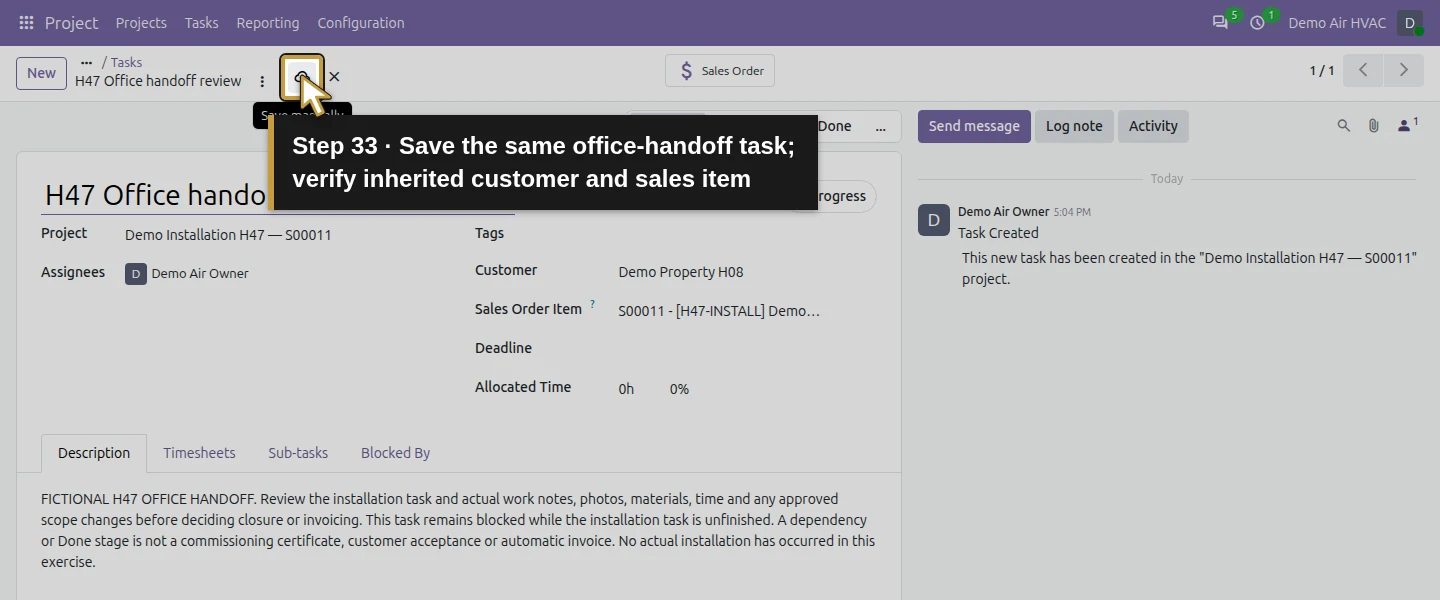

Action 33: Save the same office-handoff task; verify inherited customer and sales item. The actual target is highlighted in gold.
Save the same office-handoff task; verify inherited customer and sales item.

Step 7. Make installation depend on preparation

Open the installation task and its Blocked By tab. Click Add a line. In the task-selection dialog, check only H47 Preparation review, then click Select. Click the parent task’s Save manually and wait for it to finish. The saved installation task changes from In Progress to Waiting. The predecessor is a real selected task relation, rather than a sequence typed only in Description.

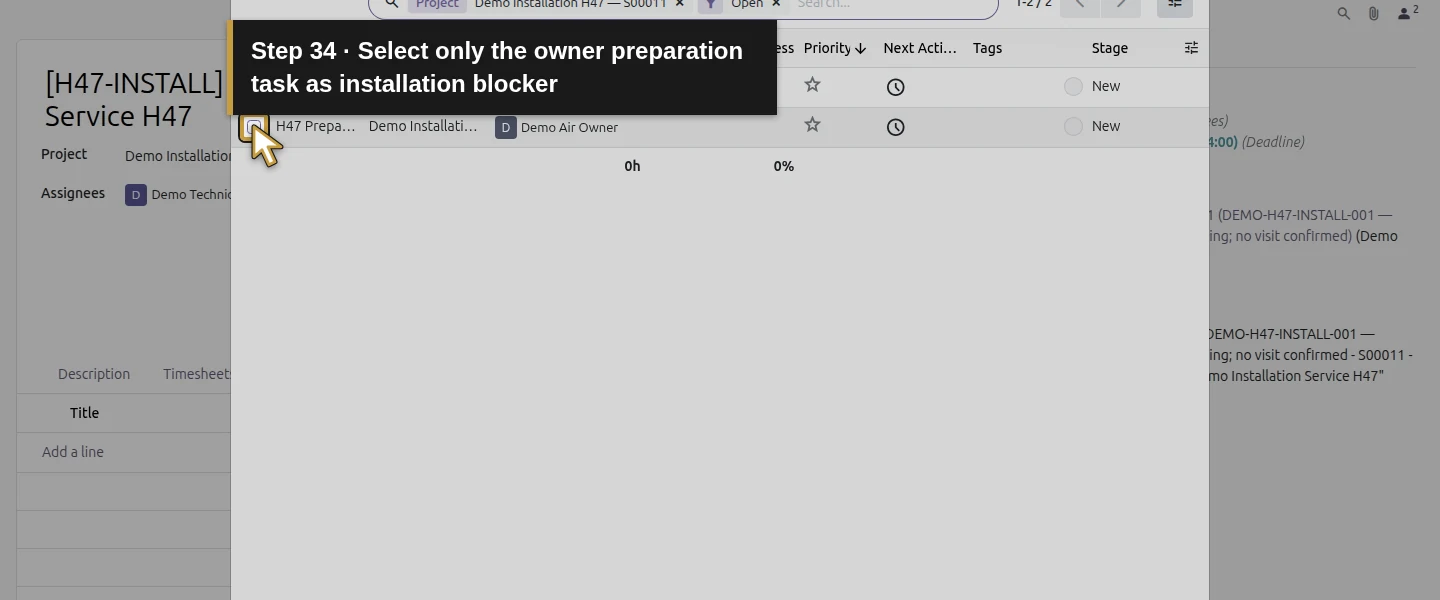

Action 34: Select only the owner preparation task as installation blocker. The actual target is highlighted in gold.
Select only the owner preparation task as installation blocker.

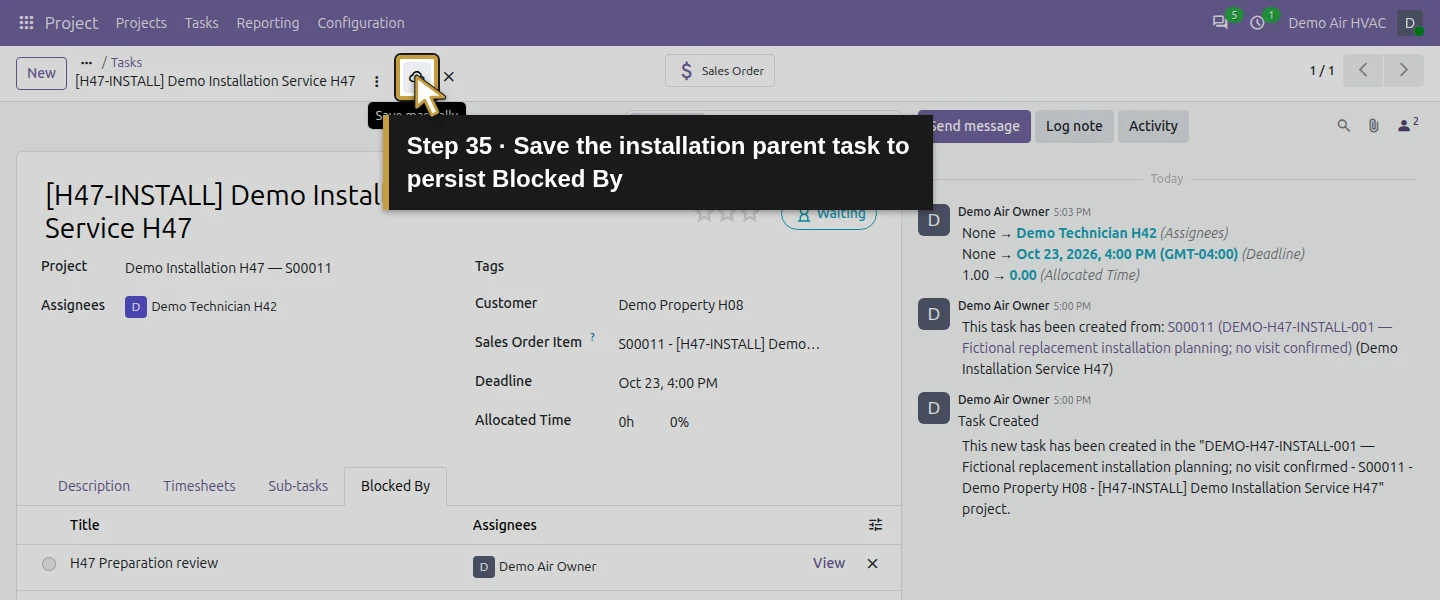

Action 35: Save the installation parent task to persist Blocked By. The actual target is highlighted in gold.
Save the installation parent task to persist Blocked By.

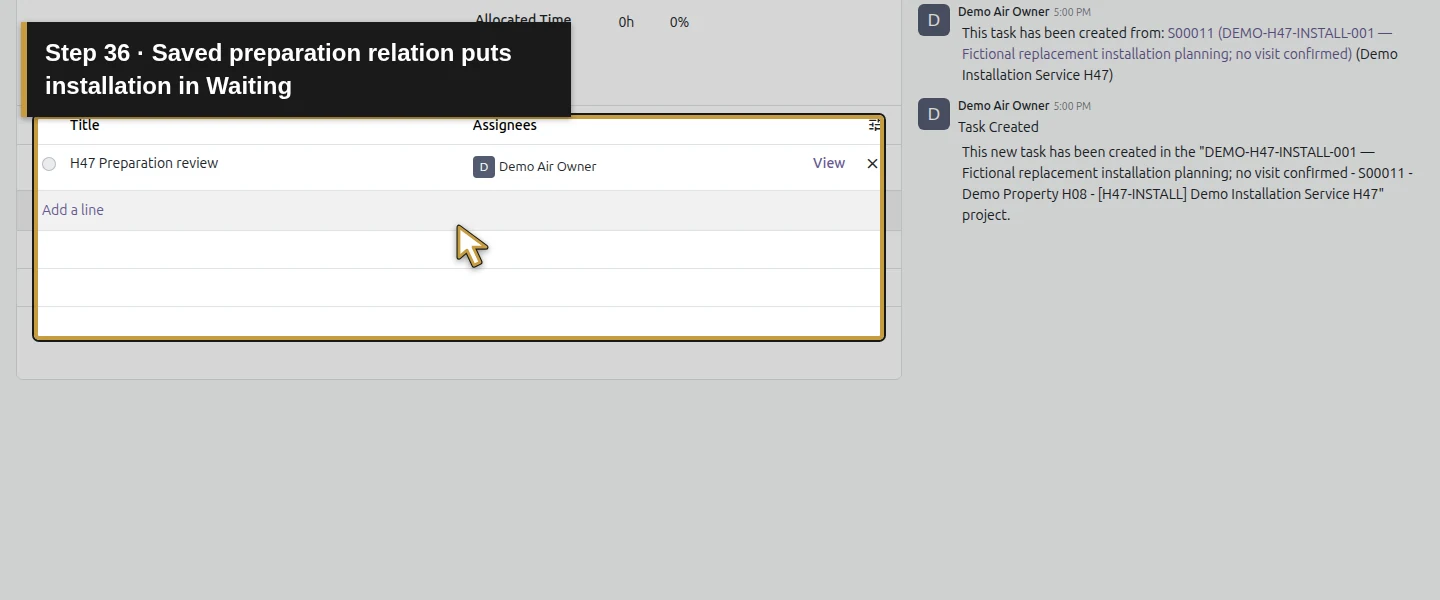

Action 36: Saved preparation relation puts installation in Waiting. The actual target is highlighted in gold.
Saved preparation relation puts installation in Waiting.

Step 8. Make office handoff depend on installation

Open H47 Office handoff review → Blocked By → Add a line. Select only [H47-INSTALL] Demo Installation Service H47, click Select and then Save manually on the parent task. Office handoff also becomes Waiting. The saved sequence is preparation → installation → office handoff. Keep all three in their existing New stage while testing the separate task states. Do not mark installation complete to release office review.

Action 37: Select only the installation task to block office handoff. The actual target is highlighted in gold.
Select only the installation task to block office handoff.

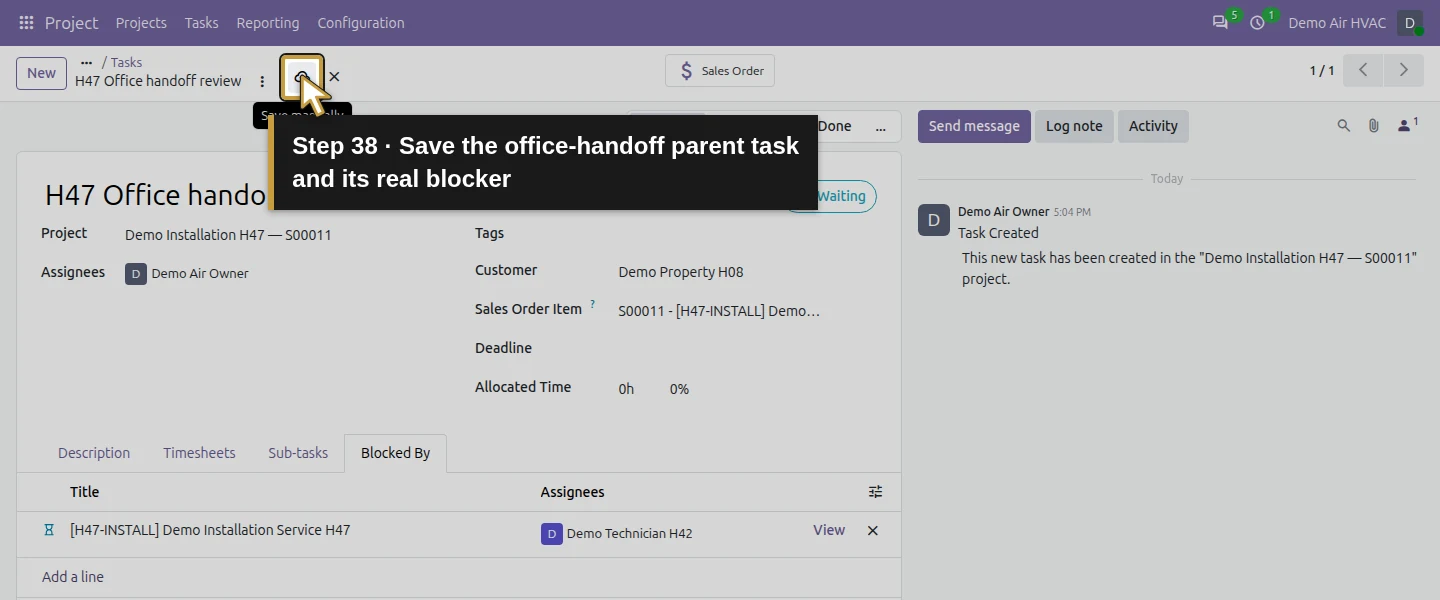

Action 38: Save the office-handoff parent task and its real blocker. The actual target is highlighted in gold.
Save the office-handoff parent task and its real blocker.

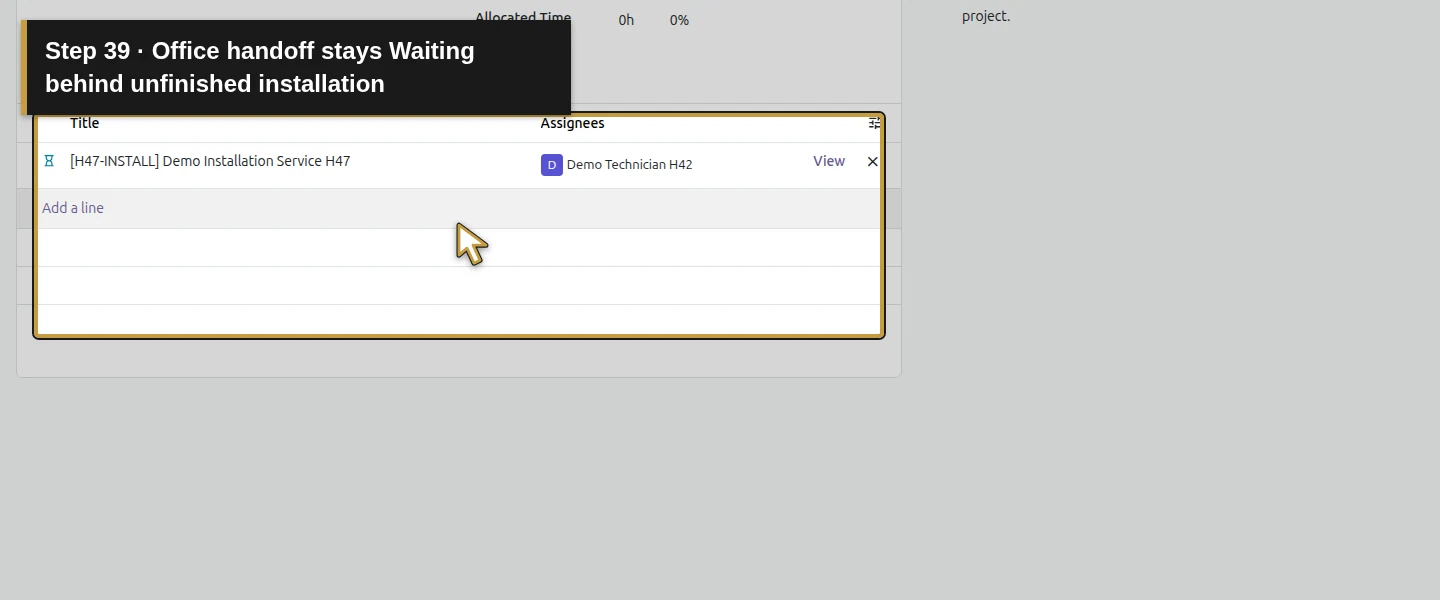

Action 39: Office handoff stays Waiting behind unfinished installation. The actual target is highlighted in gold.
Office handoff stays Waiting behind unfinished installation.

Step 9. Check the technician’s actual view

In the existing technician account, open the assigned installation task. The technician can read its Description, internal deadline, assignment and Waiting state. With this Team members only setup, its Blocked By table is empty for the technician, although the task’s chatter names the preparation dependency. A direct attempt to open the owner’s preparation task is denied read access. The owner can see the full dependency relation. Treat this as a role-specific handoff limit, not evidence that the dependency is missing or that blocker names are concealed everywhere.

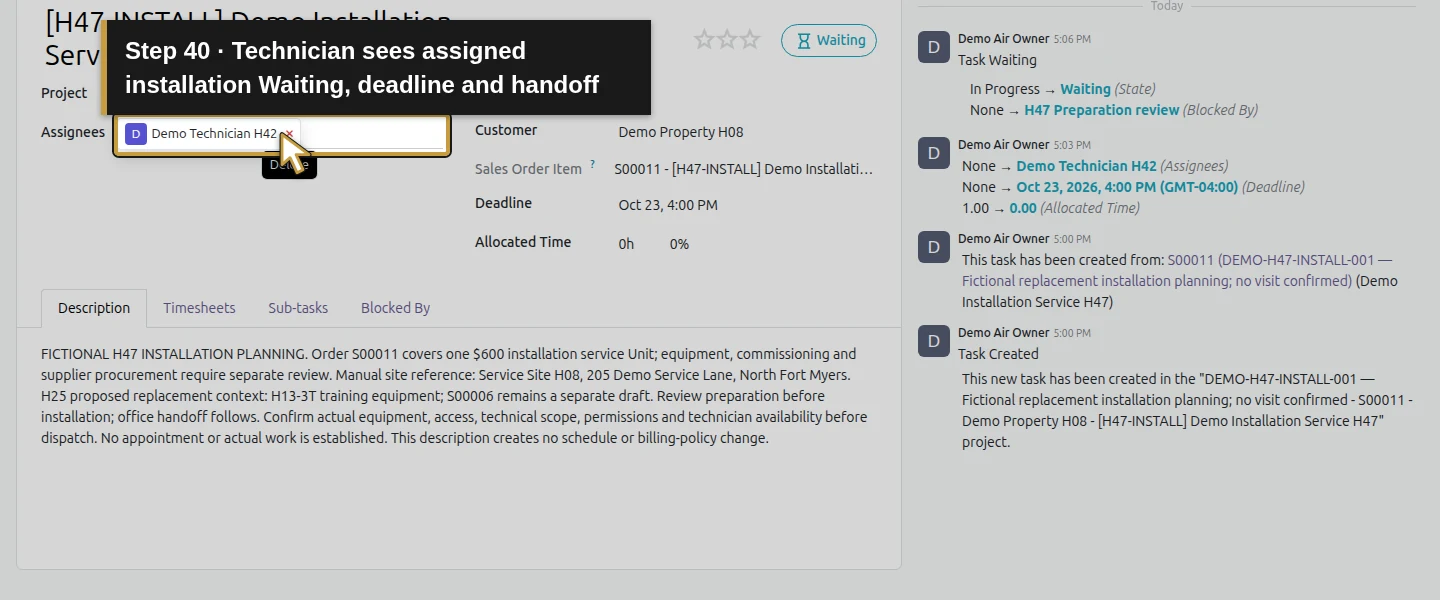

Action 40: Technician sees assigned installation Waiting, deadline and handoff. The actual target is highlighted in gold.
Technician sees assigned installation Waiting, deadline and handoff.

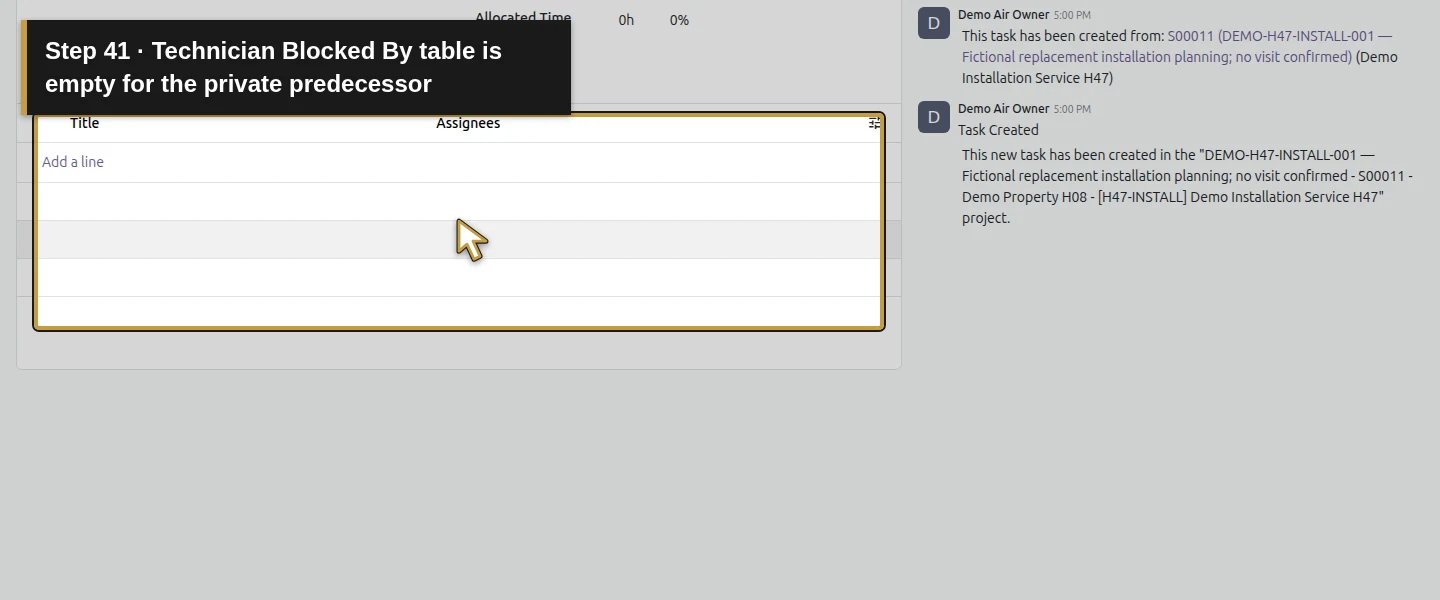

Action 41: Technician Blocked By table is empty for the private predecessor. The actual target is highlighted in gold.
Technician Blocked By table is empty for the private predecessor.

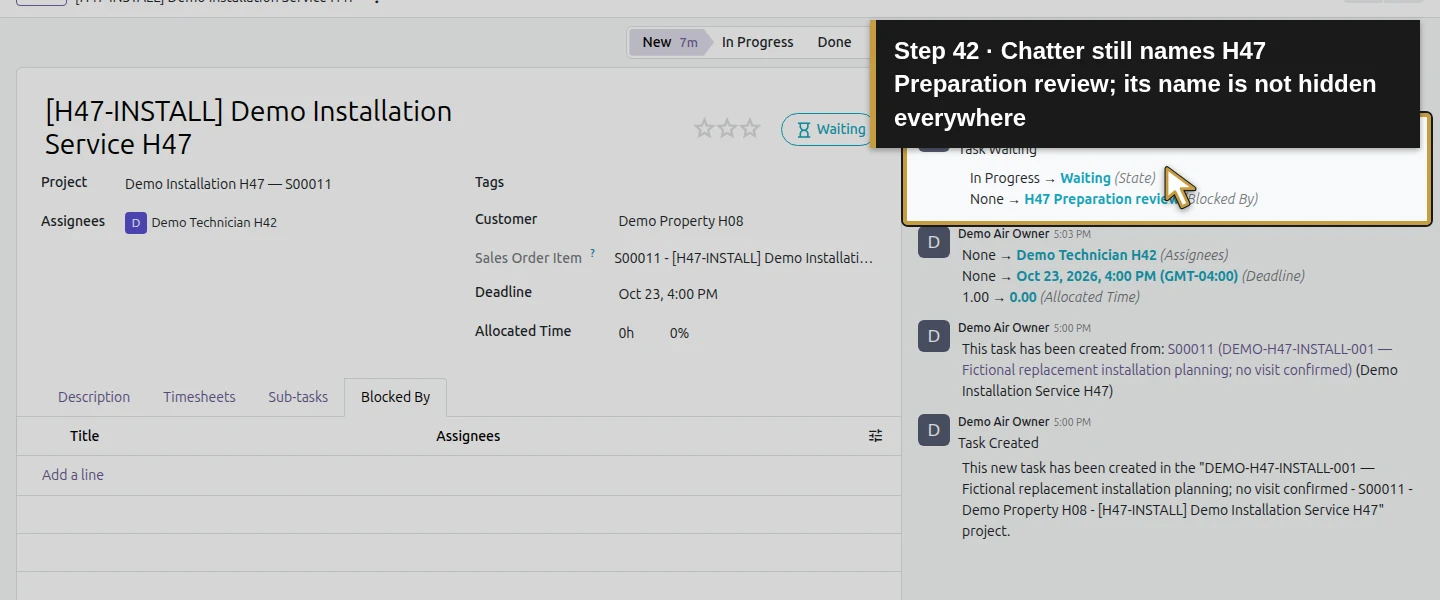

Action 42: Chatter still names H47 Preparation review; its name is not hidden everywhere. The actual target is highlighted in gold.
Chatter still names H47 Preparation review; its name is not hidden everywhere.

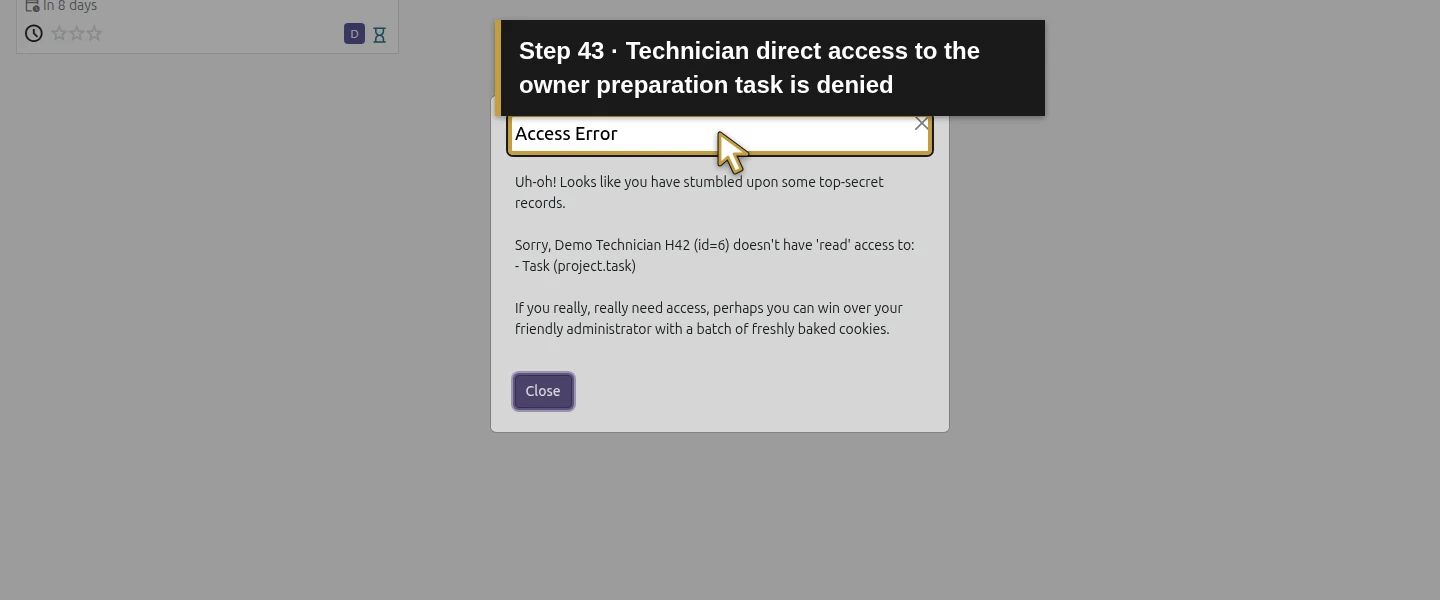

Action 43: Technician direct access to the owner preparation task is denied. The actual target is highlighted in gold.
Technician direct access to the owner preparation task is denied.

Step 10. Complete only the fictional preparation task and save

As the owner, open H47 Preparation review. Use the separate task-status dropdown currently showing In Progress, choose Done, then click Save manually. Wait for the save to finish. In the observed check, choosing Done without saving left the persisted preparation In Progress and installation Waiting. The completed synthetic review tests the dependency transition; it does not establish equipment availability, customer authorization or actual readiness to dispatch.

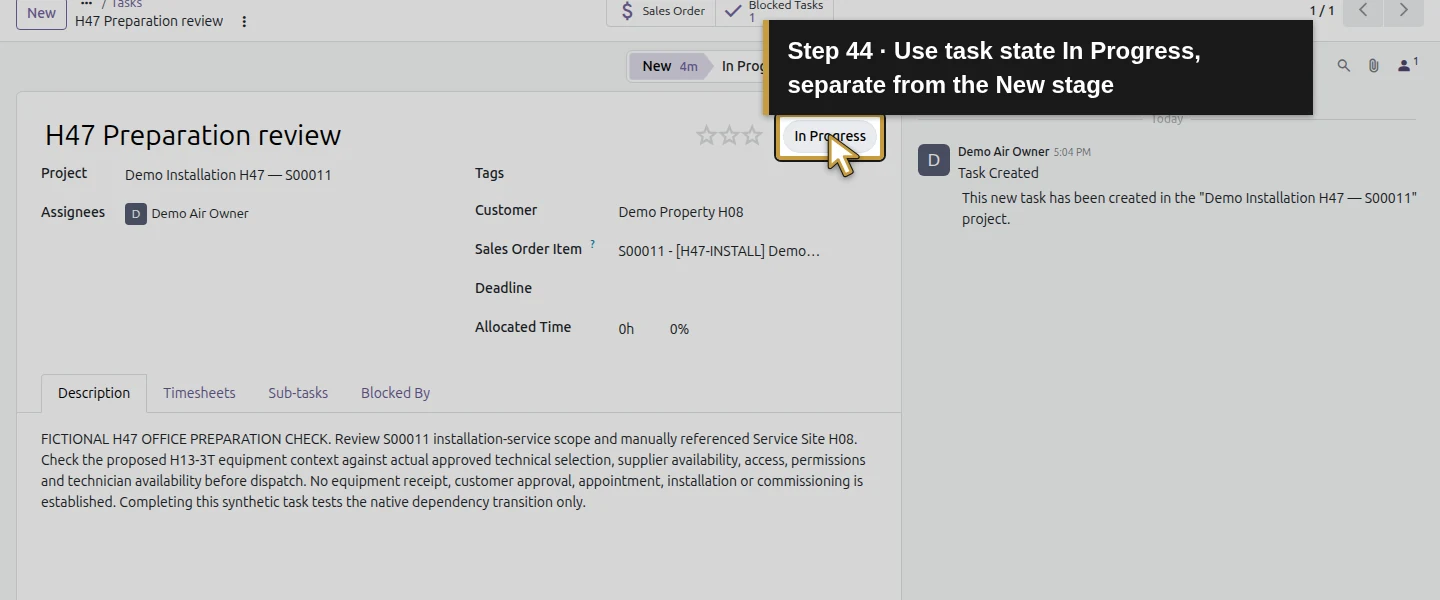

Action 44: Use task state In Progress, separate from the New stage. The actual target is highlighted in gold.
Use task state In Progress, separate from the New stage.

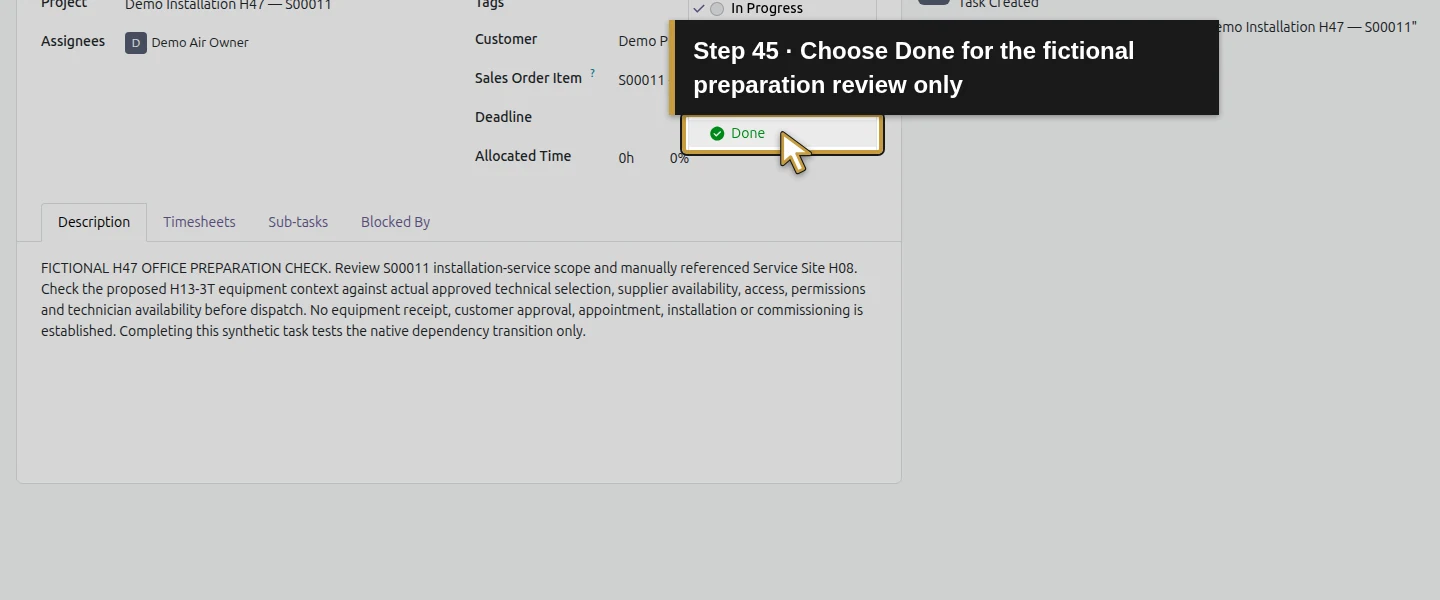

Action 45: Choose Done for the fictional preparation review only. The actual target is highlighted in gold.
Choose Done for the fictional preparation review only.
Action 46: Done choice is still unsaved; installation remains persisted Waiting. The actual target is highlighted in gold.
Done choice is still unsaved; installation remains persisted Waiting.

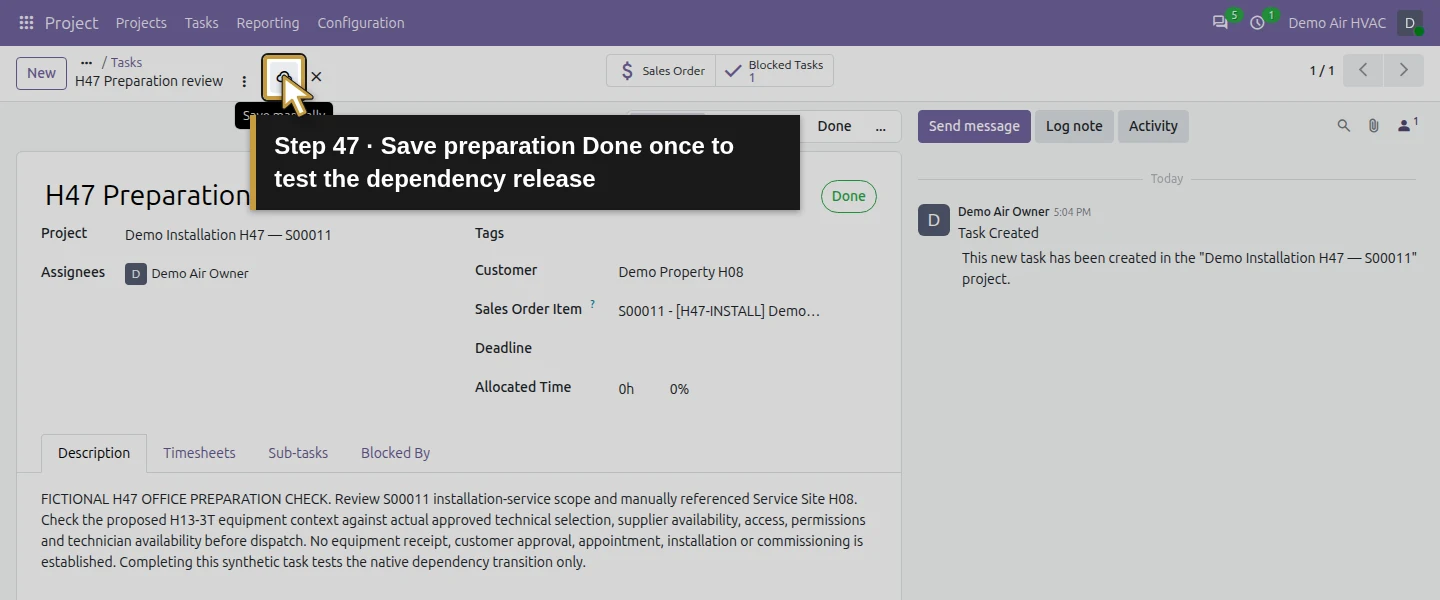

Action 47: Save preparation Done once to test the dependency release. The actual target is highlighted in gold.
Save preparation Done once to test the dependency release.

Step 11. Verify which work was released

Reopen the installation task as owner and technician. Its separate task state is now In Progress automatically, while its stage still reads New. The dependency on preparation is retained. Office handoff stays Waiting, because installation is unfinished. Preparation is Done but also remains in New stage: stage and task state are different controls. Neither the automatic In Progress state nor a New/Done stage label proves work has started or finished on site.

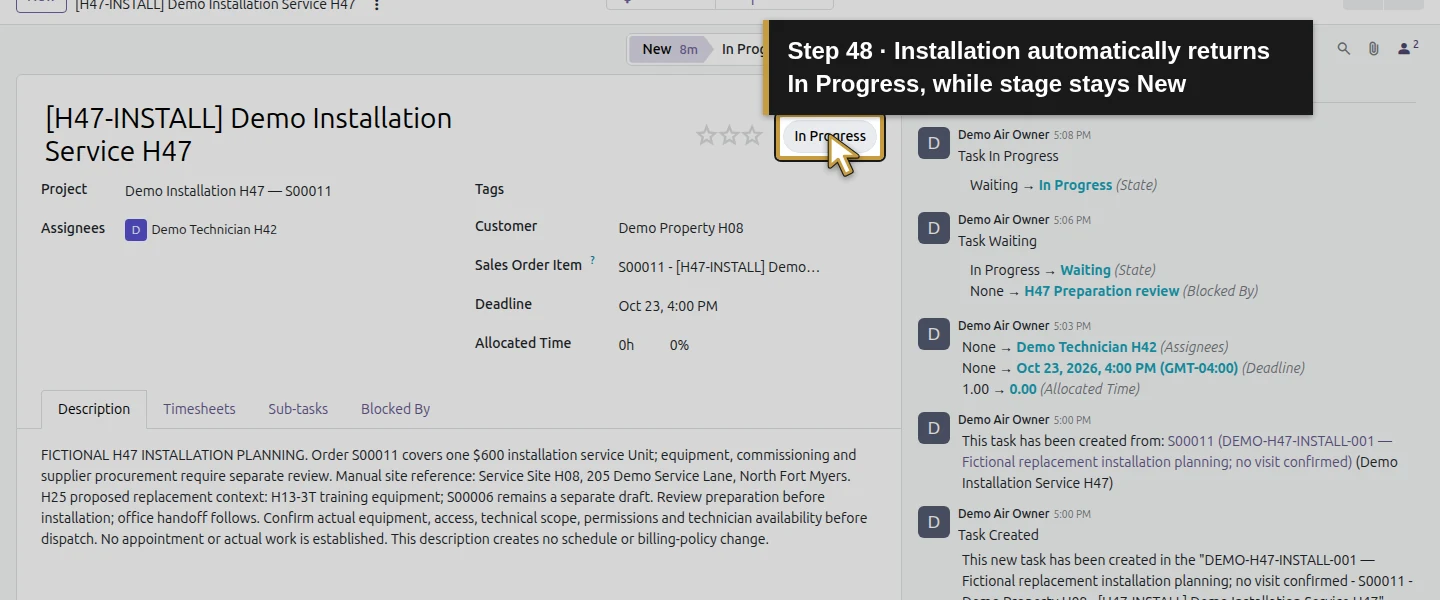

Action 48: Installation automatically returns In Progress, while stage stays New. The actual target is highlighted in gold.
Installation automatically returns In Progress, while stage stays New.

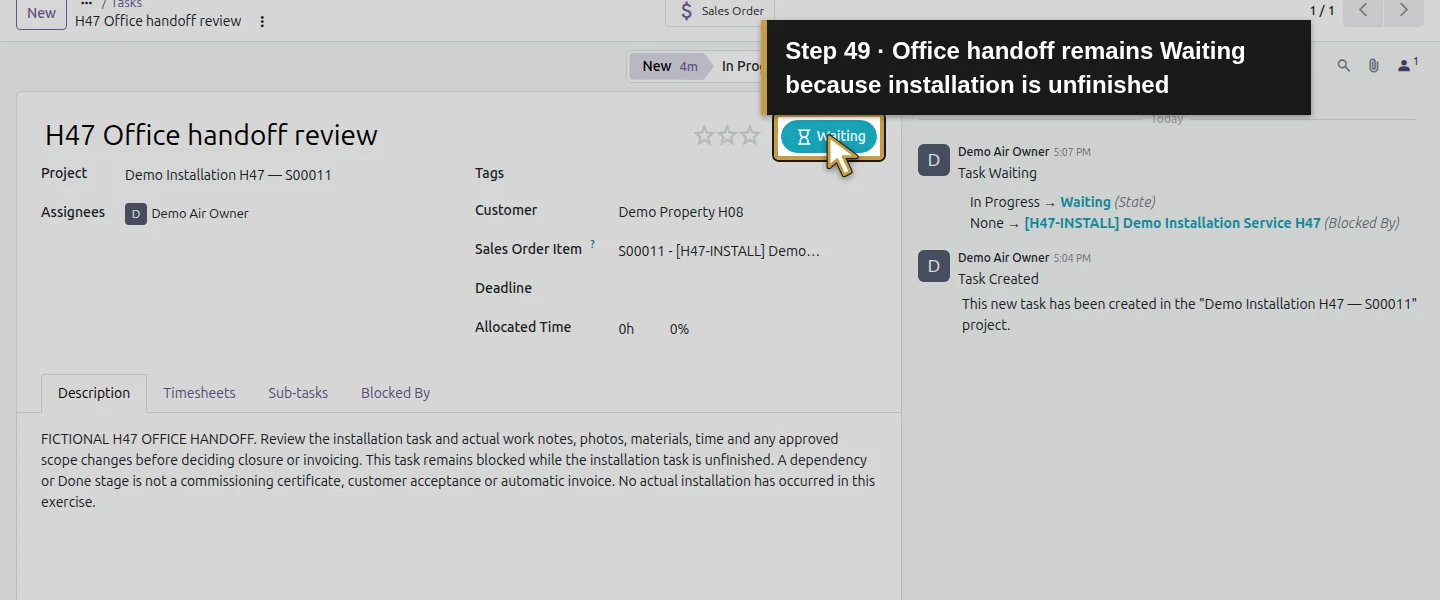

Action 49: Office handoff remains Waiting because installation is unfinished. The actual target is highlighted in gold.
Office handoff remains Waiting because installation is unfinished.

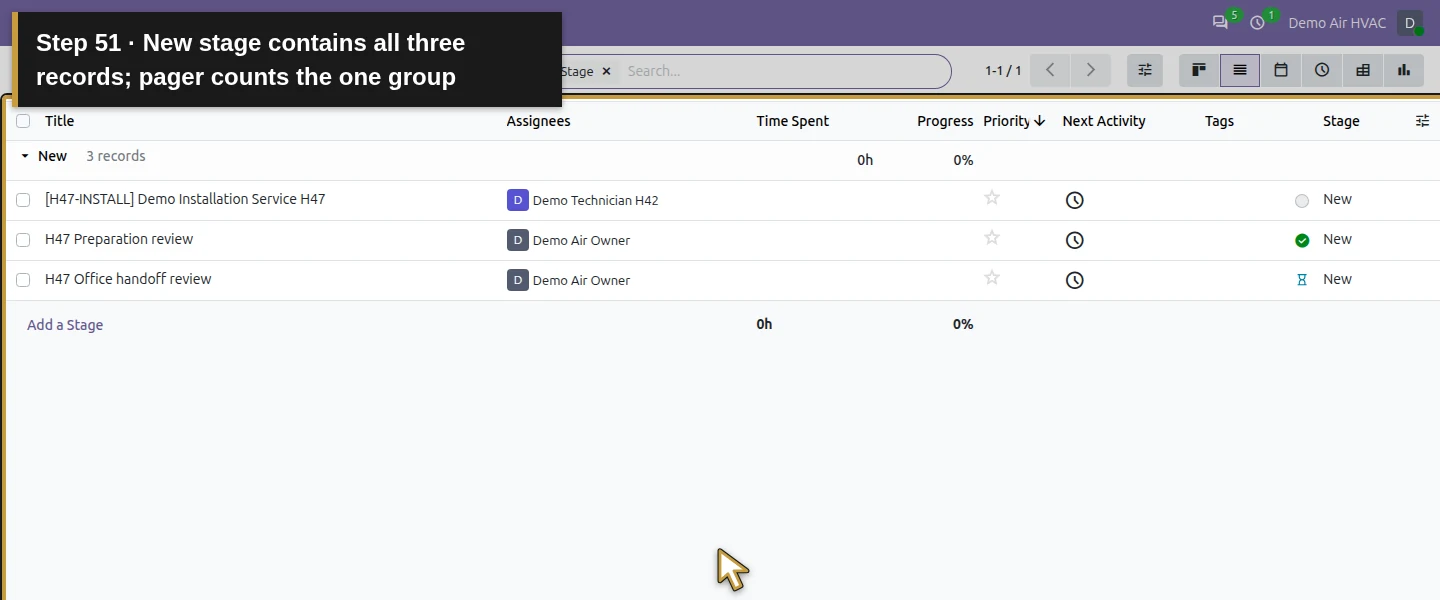

Action 51: New stage contains all three records; pager counts the one group. The actual target is highlighted in gold.
New stage contains all three records; pager counts the one group.

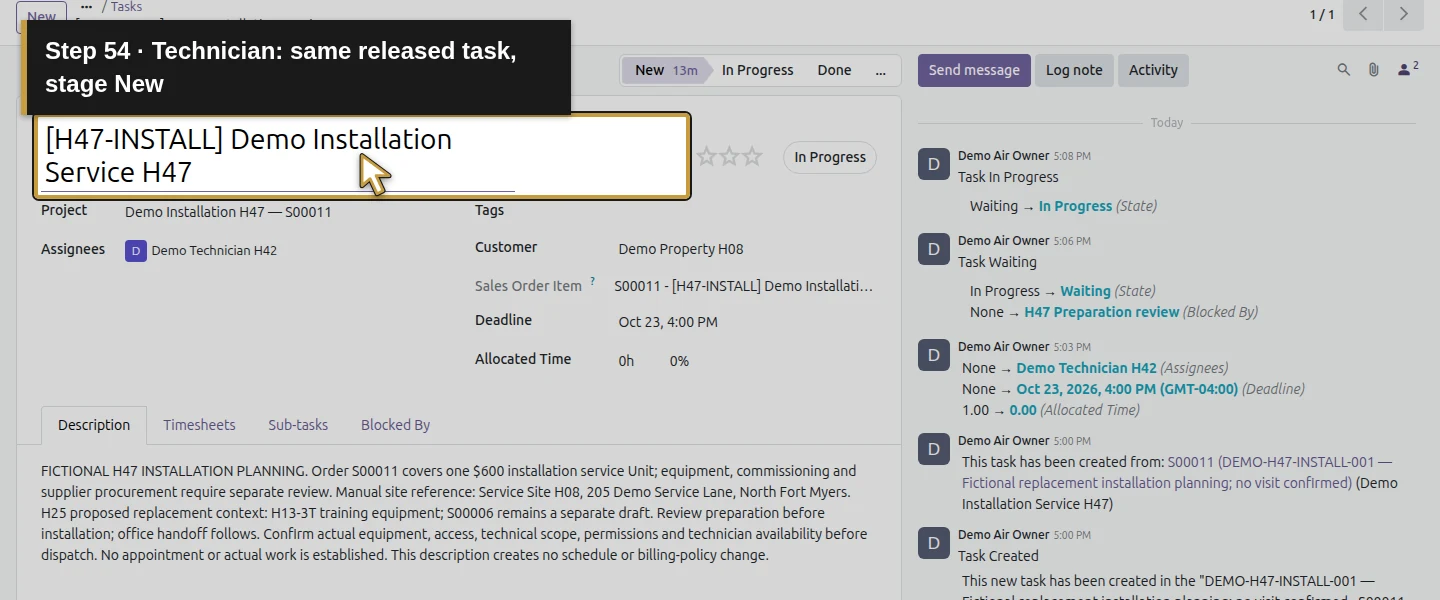

Action 54: Technician: same released task, stage New. The actual target is highlighted in gold.
Technician: same released task, stage New.

Step 12. Find all three tasks after completion

Open the owner’s project board. Its default Open filter now shows only installation and office handoff. Remove Open and choose List View to include the completed preparation task. The list has a New: 3 records group containing all three tasks. Its 1–1 / 1 counter counts the one stage group, not one underlying task. Reload and reopen the same records rather than creating replacements because a closed task disappeared from the Open view.

Action 50: Default Open shows installation and office handoff; completed prep is hidden. The actual target is highlighted in gold.
Default Open shows installation and office handoff; completed prep is hidden.
Action 51: New stage contains all three records; pager counts the one group. The actual target is highlighted in gold.
New stage contains all three records; pager counts the one group.

Step 13. Review time and billing separately from the task sequence

S00011 still has one sold service Unit, zero recorded/delivered/invoiced time or quantity and no invoice. Its fixed-price policy leaves 1 Unit to invoice even while installation is unfinished and office handoff Waiting. The three task links do not multiply the sold quantity. All three task allocations are zero after review; the project’s separate Allocated Time still shows its generated 1h, which remains an unreviewed project budget in this test. Do not interpret it as reserved capacity or an approved time estimate. Keep actual estimates, physical installation, commissioning and billing decisions explicit.

Action 20: Project Allocated Time remains an unreviewed one-hour budget. The actual target is highlighted in gold.
Project Allocated Time remains an unreviewed one-hour budget.

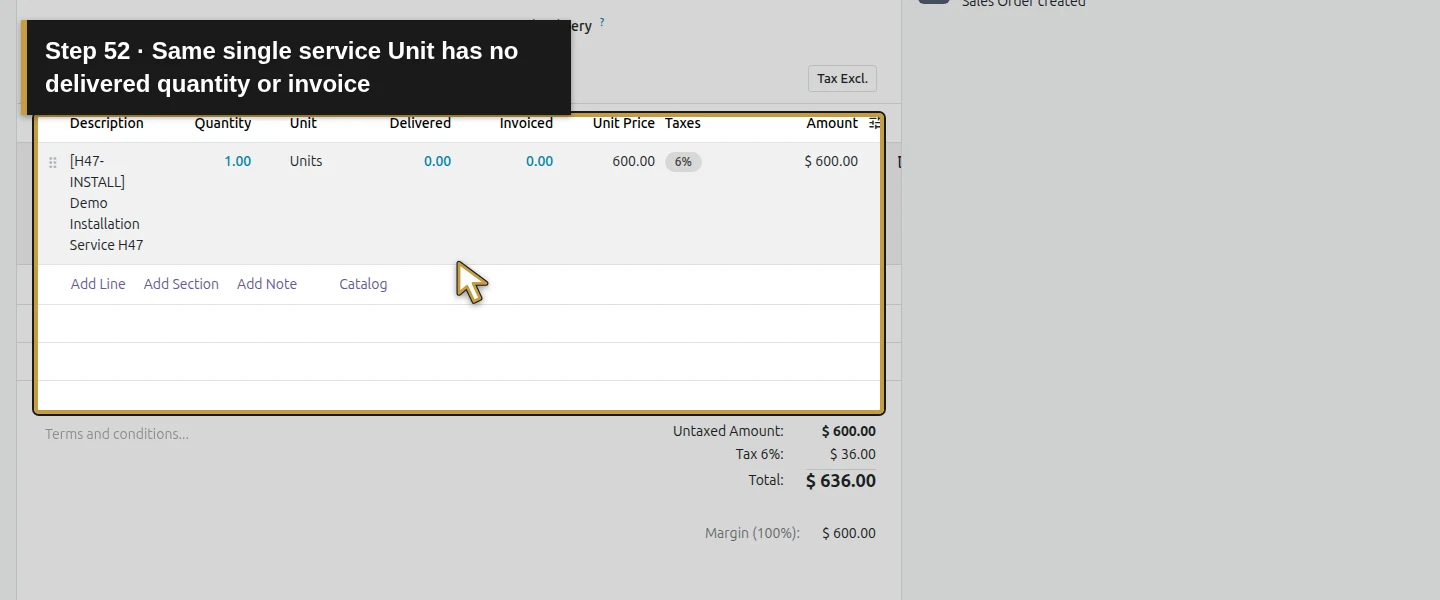

Action 52: Same single service Unit has no delivered quantity or invoice. The actual target is highlighted in gold.
Same single service Unit has no delivered quantity or invoice.

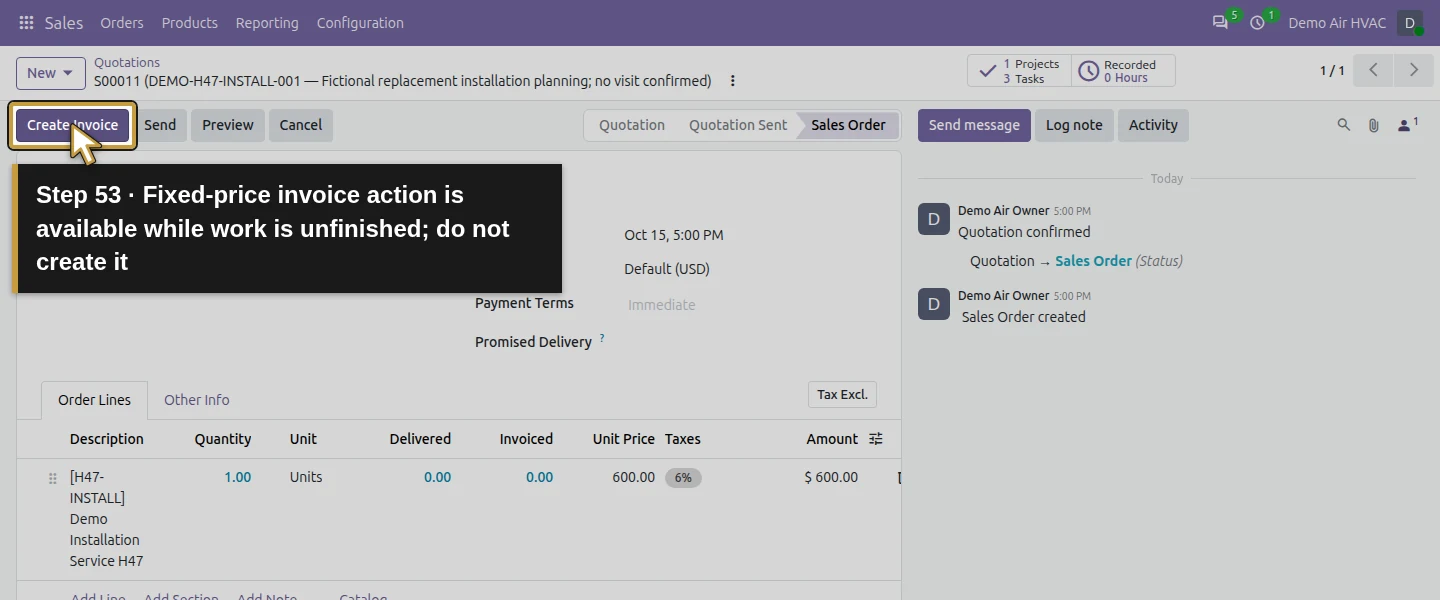

Action 53: Fixed-price invoice action is available while work is unfinished; do not create it. The actual target is highlighted in gold.
Fixed-price invoice action is available while work is unfinished; do not create it.
